Long-Span Structural Frames

The column-and-beam skeleton that carries the floor plates — steel, concrete or composite — erected around the core and kept plumb, braced and stable as it climbs.

Long-Span Structural Frames — construction process cover

Last updated 2026-07-28 by the BuildPedia Editorial Team.

What is Long-Span Structural Frames?

The frame is what turns a core into a building. Around the core goes the grid: columns on an 8–12 m spacing typical of office planning, beams or slabs spanning between them, carrying every floor plate, façade panel and desk to the foundations. Commercial frames fall into two families. The steel frame — universal columns, cellular or plain universal beams, bolted connections, composite metal deck slabs — dominates UK city offices because it is fast, light and tolerant of long spans. The concrete frame — columns with flat slabs or post-tensioned slabs, or a beam-and-slab frame — dominates Gulf towers, where ready-mixed concrete, cheap formwork labour and thermal mass suit the market, and where the frame often doubles as the fire protection and the acoustic separation for free.

Whatever the material, the engineering of erection is about temporary conditions. A steel frame is not stable until its bracing system — vertical braced bays, shear connections to the core, or the diaphragm of the completed floor — is in place, and the erection method statement works in sequences that keep every bay stable at every stage. In the UK, fabricated steelwork arrives CE/UKCA-marked to BS EN 1090 at Execution Class 2 or 3, erected to the National Structural Steelwork Specification with alignment surveys at each tier. In the Gulf, concrete frames climb behind the core on table forms with back-propping two or three floors deep, and post-tensioned slabs are stressed, grouted and released on a weekly cycle — the frame and the floor plate are the same operation.

The tall-building problem is accumulation. A column a few millimetres out of plumb per storey is a tower leaning by the time the façade designer asks for his fixing tolerances, and a frame erected level on average can still hide individual columns far enough out to break the curtain walling's adjustment range. The frame is surveyed tier by tier — position, plumb, level — against tolerances the façade and core teams have agreed they can live with, because from here on, every trade hangs off the frame's geometry.

When and why is Long-Span Structural Frames used?

Frame erection follows the core up the building, typically a few floors behind, and runs in parallel with the floor plates — on a steel frame the decking follows the steel almost immediately; on a concrete frame the slab is the floor plate. The material choice is made early and on commercial logic: steel where speed, long spans and site congestion argue for dry construction and a small site workforce; concrete where material economics, fire strategy, acoustics and local skills argue for wet construction and a bigger one. It matters because the frame sets the building's rhythm — one floor per week per crane on steel, a weekly pour cycle on concrete — and because its geometry is the reference for the three trades that follow and cannot forgive error: the floors that land on it, the façade that bolts to its edges, and the partitions and risers that repeat its grid forty times over.

Types of Long-Span Structural Frames

Braced steel frame with cellular beams

Universal columns and beams with web openings for services, stability from vertical braced bays or the concrete core, and composite deck slabs. The UK city office standard: fast erection, services threaded through the beams rather than under them, and fire protection by intumescent coating or boarding applied after.

Composite steel-concrete frame

Steel columns and beams acting compositely with the concrete slabs through shear studs — sometimes with slim-floor or integrated beam sections to flatten the construction depth. The efficiency play: less steel, less depth, and the slab working as part of the beam rather than dead weight on it.

Post-tensioned concrete flat-slab frame

Concrete columns with flat slabs — no downstand beams — post-tensioned with bonded or unbonded tendons stressed after the concrete hardens. The Gulf tower default and common on UK residential-over-commercial podia: thin slabs, flat soffits for services and ceilings, and a fast table-form cycle.

Concrete frame with shear walls and core

A conventional column-and-slab reinforced concrete frame relying on the core and shear walls for stability, built to BS EN 13670 execution tolerances with the frame and floor plates cast together. Robust, fire-resistant and quiet — but every floor is a formwork, reinforcement, pour and striking cycle, and the programme runs on concrete strength gain, not crane lifts.

Long-Span Structural Frames: step by step

Step 1: Set out, check and grout the base connections

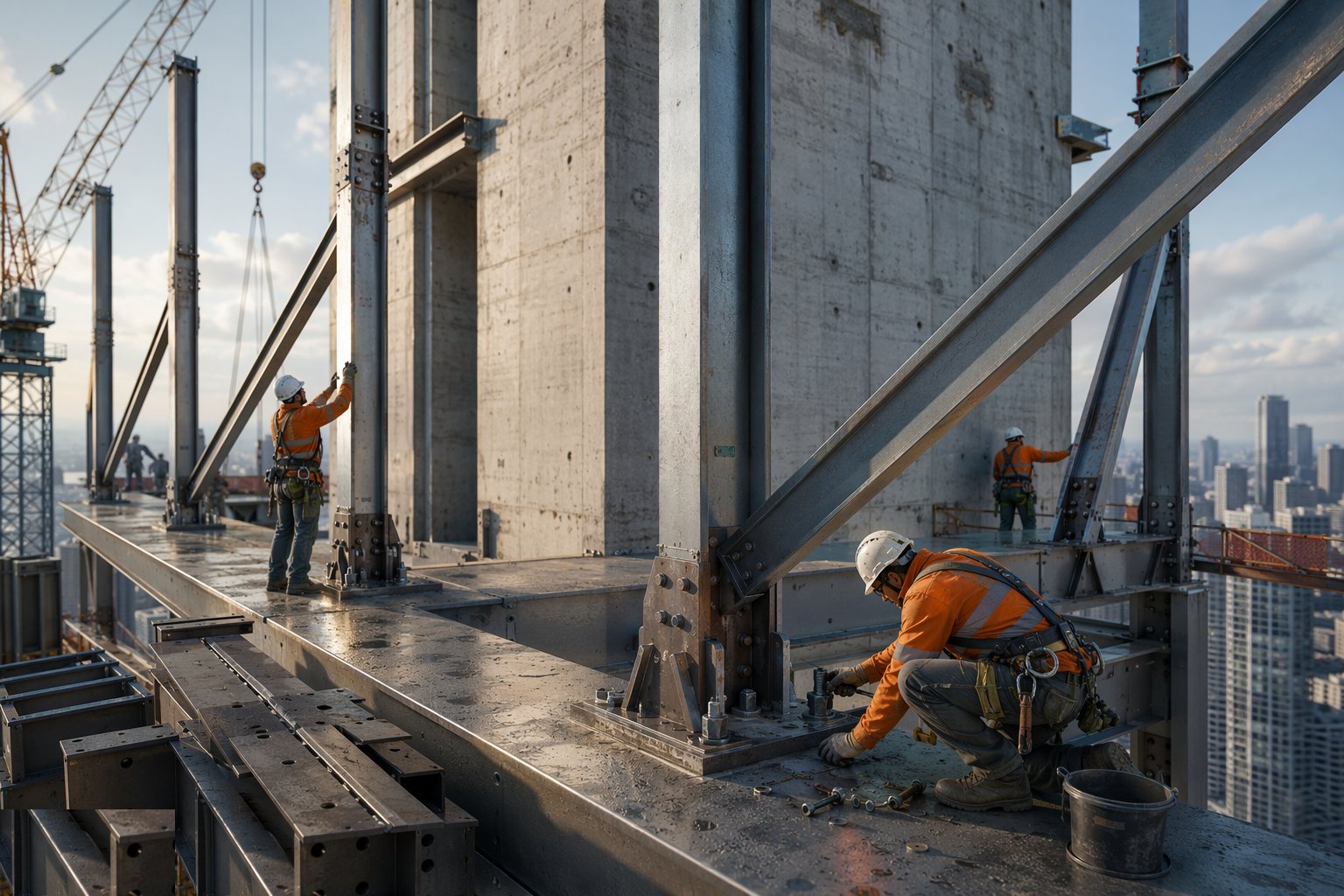

Set out, check and grout the base connections — Long-Span Structural Frames, step 1

Everything downstream hangs off the first tier. Holding-down bolt groups are surveyed against the grid before columns arrive — cast-in bolts that have wandered beyond the adjustment of the base plates mean drilled-in retrofit anchors and a design query on day one. Columns are landed, levelled on shim or screw jacks, plumbed, and the bases grouted with non-shrink grout once alignment is confirmed — not before, because grout poured to a wrongly set column is a demolition job. On concrete frames, the equivalent discipline is the starter bars and kickers from the core and transfer levels: couplers checked, kickers cast true, and the first lift of columns plumbed against survey control.

Step 2: Erect columns and beams in a stable sequence

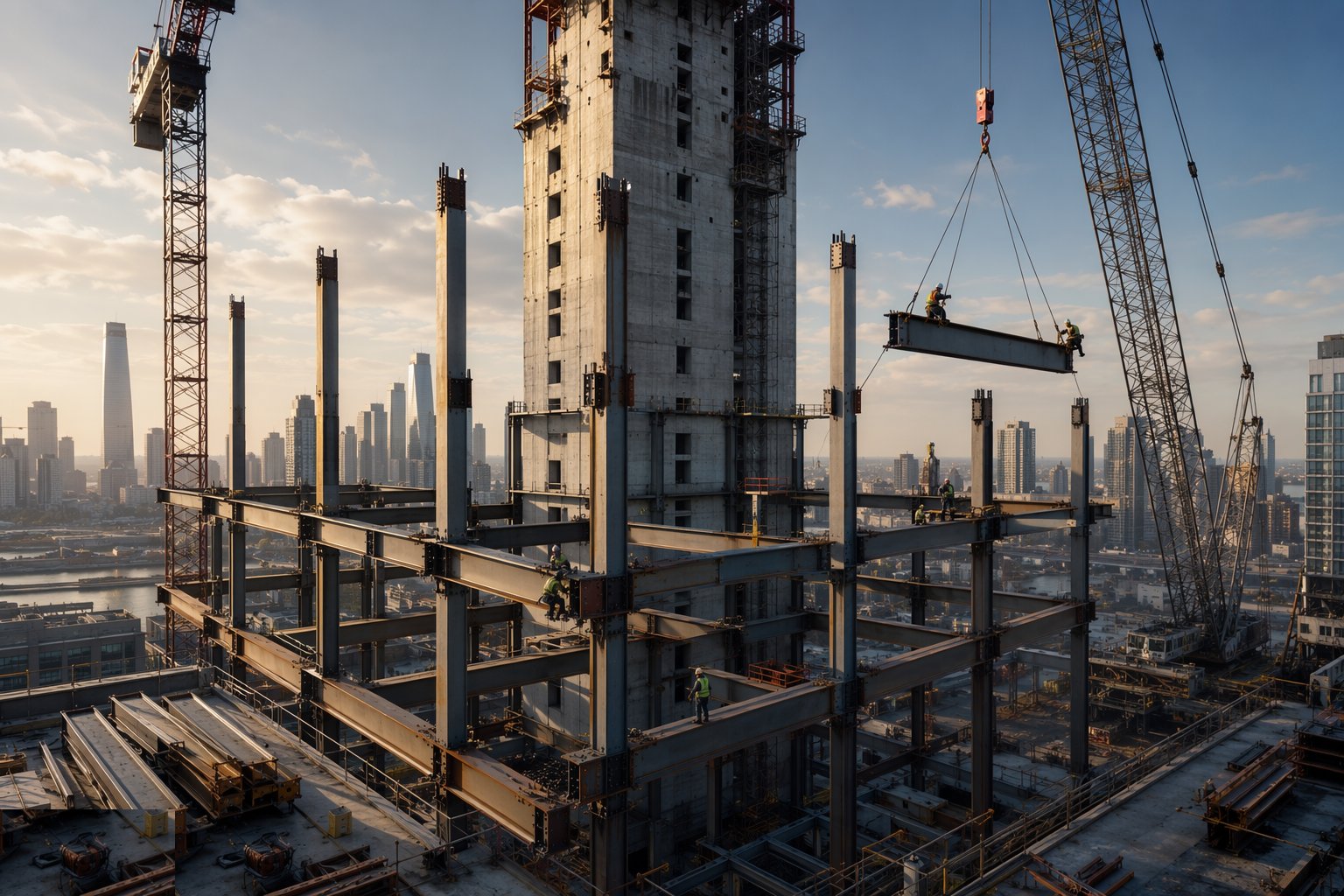

Erect columns and beams in a stable sequence — Long-Span Structural Frames, step 2

Steel erection follows the method statement bay by bay: columns first, beams connecting them, and the braced bay or core connection completed before the crane wanders off to the next area — an unbraced line of columns is a row of dominoes waiting for a gust or a nudge. Two-bolt minimum rule on connections as members are landed, erection bolts until the permanent bolting follows, and guys, props or temporary bracing wherever the sequence demands. Concrete frames run their own sequence: column forms struck and columns standing before the table forms fly in, edge protection on the slab edge before the deck is a workplace.

Step 3: Complete the connections: bolts and welds

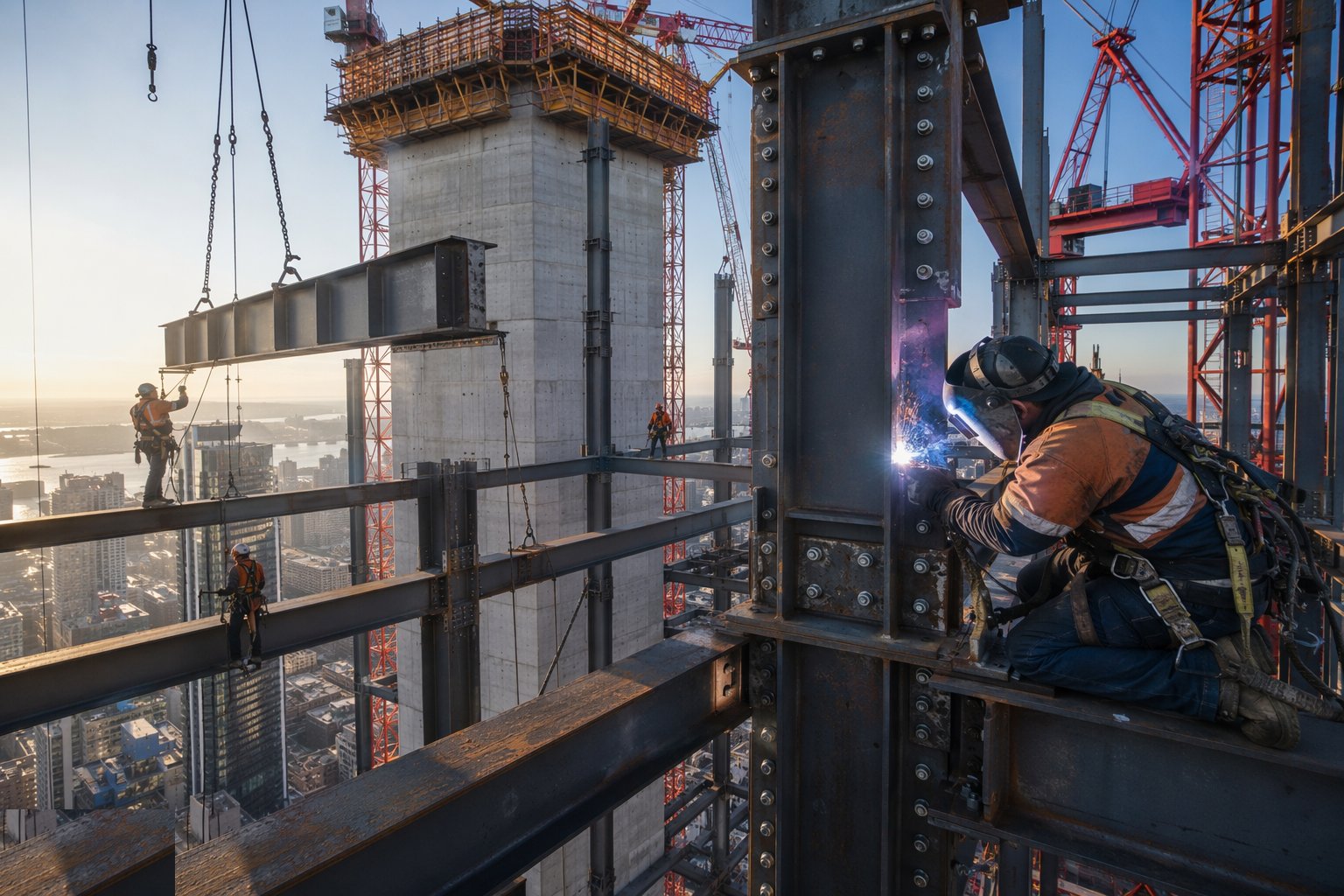

Complete the connections: bolts and welds — Long-Span Structural Frames, step 3

Bolted connections are completed with the specified bolts, tightened by the specified method — pre-loaded HSFG assemblies in slip-critical connections tightened with torque or part-turn methods and verified, bearing-type connections snugged and checked. Untorqued or wrongly assembled pre-loaded bolts are the classic latent frame defect: invisible, load-critical, and found either by the torque audit or by a slipping joint under load. Site welding, where specified, is done by coded welders to approved procedures with the specified level of NDT — in most commercial frames welding stays in the fabrication shop precisely because site welding is slow, expensive and weather-dependent.

Step 4: Survey and correct the alignment, tier by tier

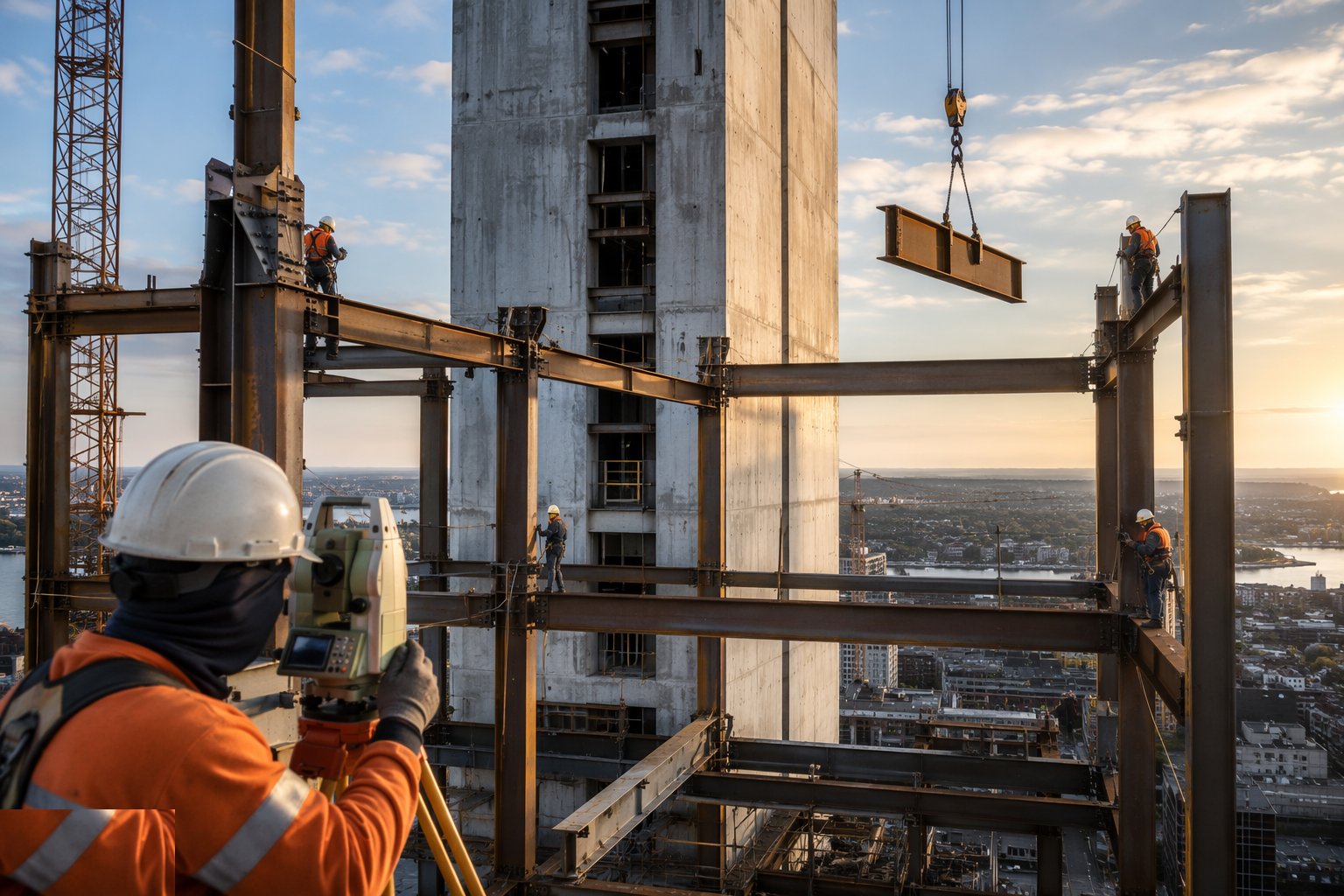

Survey and correct the alignment, tier by tier — Long-Span Structural Frames, step 4

Each tier is surveyed after erection and before the floors lock it in: column plumb and position, beam levels, overall frame geometry against the NSSS or project tolerances and — critically — against what the façade can absorb. Corrections are made by adjustment at the tier above, never by forcing members, and the survey record goes to the decking, slab and façade teams as their working datum. On concrete frames the same check applies to column plumb and slab edge positions; the edge of slab is the curtain waller's fixing line and it is surveyed like one.

Step 5: Integrate temporary stability with the permanent works

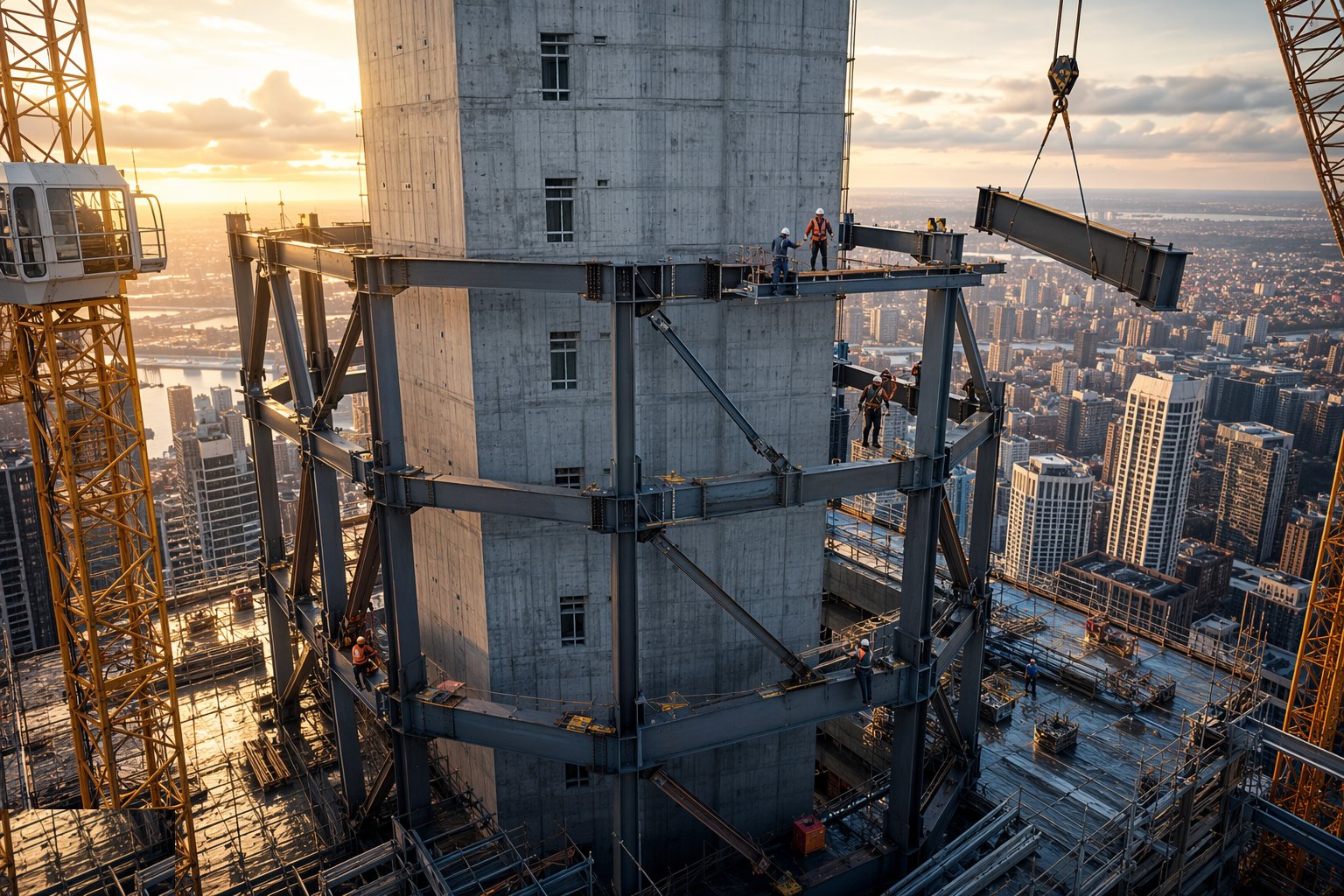

Integrate temporary stability with the permanent works — Long-Span Structural Frames, step 5

The frame is stable permanently only when the bracing, core connections and floor diaphragms are complete — until then, stability is a temporary works problem with a named owner under BS 5975 and the Temporary Works Coordinator. Erection sequences are planned so that no stage leaves the frame reliant on the crane for stability; decking is spread and fixed promptly because the deck is the diaphragm; and on concrete frames, back-propping between floors is designed, installed and struck to a sequence that respects the loads from wet concrete above — a fresh slab plus its formwork and plant routinely exceeds the design imposed load of the floor carrying it.

Step 6: Apply fire protection and corrosion protection

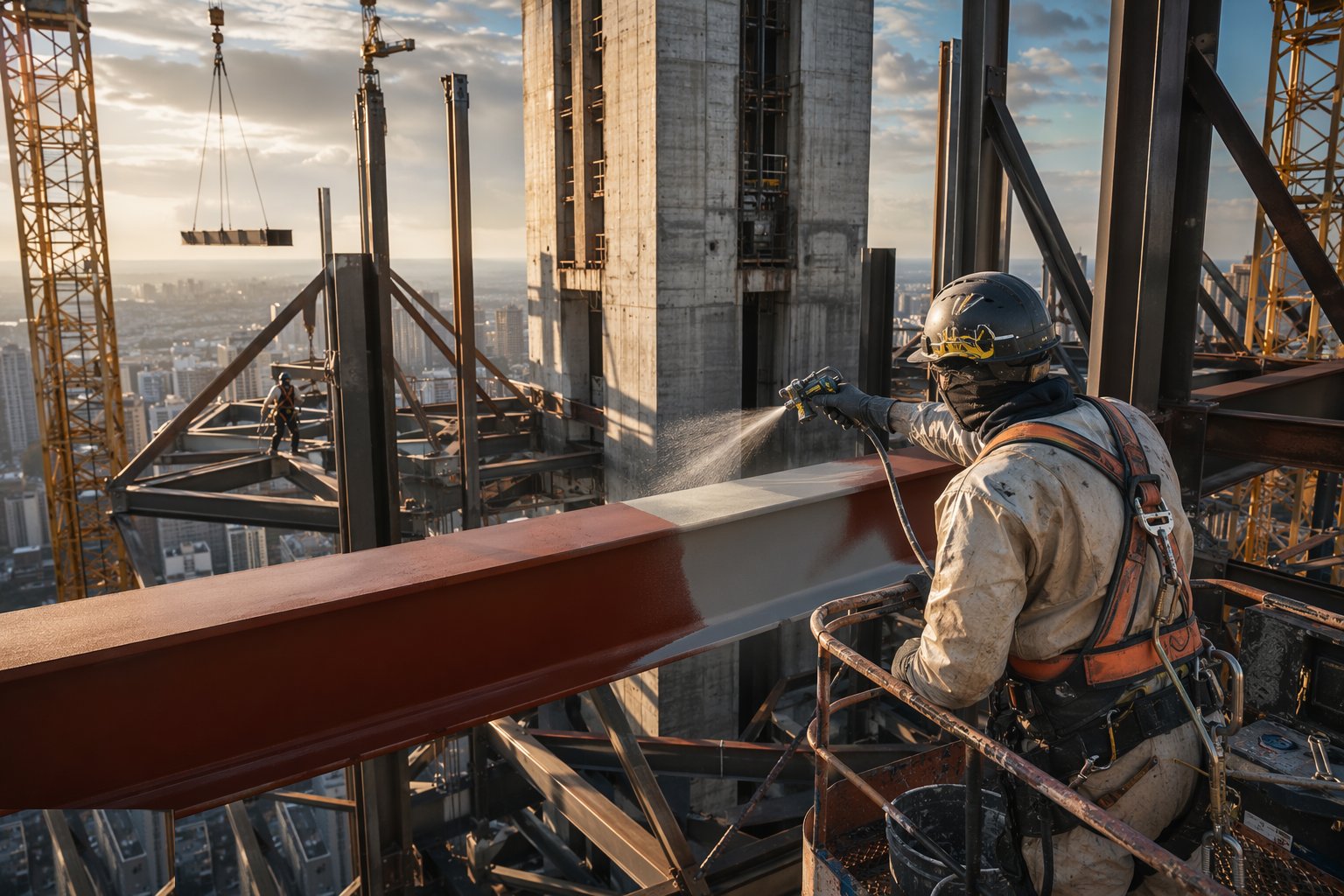

Apply fire protection and corrosion protection — Long-Span Structural Frames, step 6

Steel has no inherent fire resistance: the intumescent coating, board or spray that gives the frame its 60, 90 or 120 minutes is applied after erection, to the specified dry film thickness or board thickness, with repairs where erection damage stripped the shop-applied primer or coating. In the UK the specification follows the fire strategy and the coating manufacturer's assessment; in the UAE the fire protection system must be listed and approved under the UAE Fire and Life Safety Code with Civil Defence sign-off. Corrosion protection is inspected with the same discipline — a tower frame near the Gulf coast with damaged galvanising or paint is a maintenance liability cast into the structure.

Plant and equipment

Quality control checks

Safety considerations

Common defects

Best suited for

How long does Long-Span Structural Frames take?

Typical duration: Steel frames typically erect at around one floor per week per crane on a regular grid; concrete frames run a one-to-two-week cycle per floor including propping — a 30-storey frame is a 7–12 month operation from first column to roof..
