Curtain Walling & Unitised Façades

The weather skin of the tower — factory-glazed unitised panels hung off the slab edges — where bracket setting-out, logistics and testing decide whether it leaks, rattles or just works.

Curtain Walling & Unitised Façades — construction process cover

Last updated 2026-07-28 by the BuildPedia Editorial Team.

What is Curtain Walling & Unitised Façades?

Above the podium, a modern commercial tower wears curtain walling: a non-load-bearing glazed envelope hung off the edges of the floor plates, carrying only its own weight and the wind back to the structure. The dominant system on towers is unitised — complete panels, typically one storey high and 1.2–1.8 m wide, manufactured and glazed in a factory, shipped to site on stillages, and hooked onto brackets cast into or drilled onto the slab edge. The alternative is stick curtain walling, where mullions, transoms and glass are assembled piece by piece on site — flexible for podiums and awkward geometry, but slow and weather-exposed on a tall repetitive tower. Around the same slab edges sit the secondary items that decide whether the façade performs: fire-stopping and cavity barriers closing the gap between slab edge and panel, and the movement joints that let the frame sway and shorten without racking the glazing.

The tolerances are the story. A unitised panel might carry ±5 mm of adjustment in its brackets; the frame behind it carries its own erection tolerances, the slab edge its construction tolerance, and the cast-in channel its setting-out error — and all of those stack up at the one bolt that has to engage. The façade contractor therefore surveys the as-built slab edges before brackets are set, designs the bracketry to swallow the measured reality, and sets out from the survey, not the drawings. Towers that skip this conversation discover it at panel level, where a bracket that cannot reach its cast-in channel is a redesign at 100 m up.

Regulation has made the envelope a life-safety structure. In the UK, post-Grenfell rules under the Building Safety Act and Approved Document B put the combustibility of every façade component under scrutiny, with cavity barriers at compartment lines and a golden thread of evidence from design to installation. In the UAE, the façade requires Dubai Civil Defence approval under the UAE Fire and Life Safety Code of Practice — flame-spread tested systems, listed materials, and House of Expertise third-party review on applicable projects. Performance is proven by test: unitised systems are prototype-tested for air leakage, water penetration and structural performance to CWCT standards or ASTM/AAMA methods, and site-installed façades are hose-tested on sample areas to AAMA 501.2 or CWCT site methods before the fleet of panels goes up unchallenged.

When and why is Curtain Walling & Unitised Façades used?

Façade installation follows the frame and floor plates with a deliberate lag — typically starting once several floors of structure are complete and surveyed — because the brackets fix to finished slab edges and the programme needs the frame's geometry settled, not promised. It matters because the envelope is on the critical path to weathertightness, and weathertightness gates everything internal: MEP first fix, Cat A fit-out, and the drying-out of the building all wait for closed elevations. The unitised decision is logistics as much as engineering: hundreds of panels per elevation zone must be manufactured, shipped, landed, lifted and hooked in a continuous flow, on a city site with no storage, using the tower crane or dedicated mini cranes and monorails at the slab edge. A tower that gets its panel logistics wrong has a very expensive glass traffic jam; one that gets its brackets and testing right weathertights a floor a week and never thinks about the envelope again.

Types of Curtain Walling & Unitised Façades

Unitised curtain walling

Factory-assembled, factory-glazed panels hung from slab-edge brackets and interlocked with gaskets at every joint. Quality is made in the factory; site work is bracket set-out, lifting and hooking. The tall-tower default in both the UK and the Gulf, where repetitive floors and limited site storage reward off-site manufacture.

Stick curtain walling

Mullions and transoms assembled on site, glazed and pressure-plated in place. Slower and weather-dependent, but adaptable — the answer for podiums, double-height spaces, corners of complex geometry, and anywhere panels cannot repeat.

Structural silicone glazing (SSG)

Glass bonded to the frame with structural silicone rather than captured by pressure plates, giving the flush, frameless look. The silicone is doing structural work — factory-bonded under controlled conditions with adhesion testing and a quality regime that treats every bond as load-bearing, because it is.

Rainscreen and over-cladding zones

Opaque areas — spandrels, plant floors, podium facings — clad in drained and back-ventilated rainscreen panels over a weather-resistant backing wall, with stone, terracotta, GRC or metal panels on helping-hand brackets. The panel is the raincoat, not the waterproofing; the cavity, its barriers and the backing wall do the weather work.

Curtain Walling & Unitised Façades: step by step

Step 1: Survey the slab edges and design the brackets

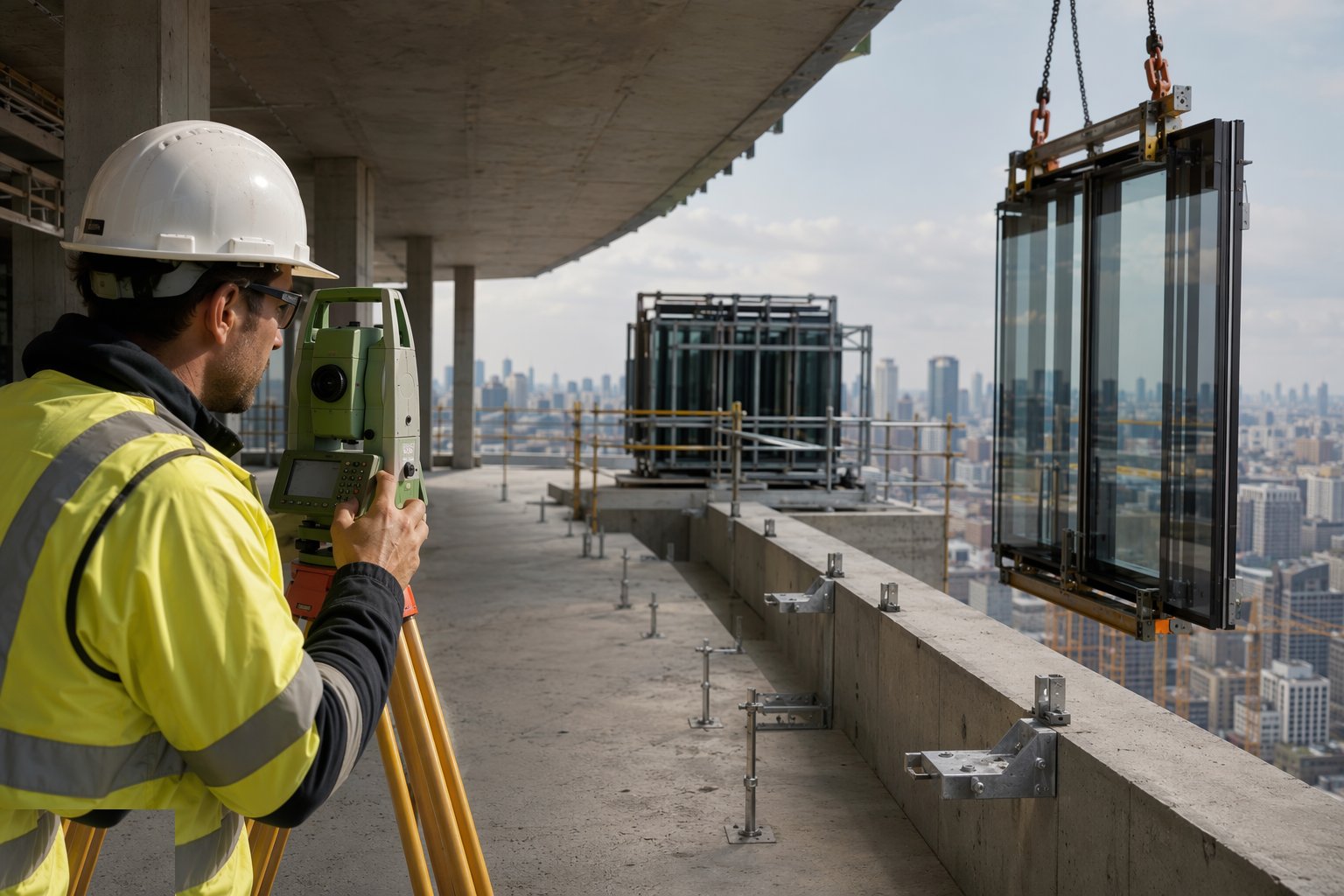

Survey the slab edges and design the brackets — Curtain Walling & Unitised Façades, step 1

Before a bracket is set, the as-built slab edges are surveyed — position, level and verticality, floor by floor, against the design line. The bracketry is then detailed to absorb the measured reality within its adjustment range: where the concrete has drifted, bracket variants or packers are engineered, not improvised. Cast-in channels are checked for position and tested where their capacity is in question; post-drilled anchors are installed to their ETA with setting tools, torque and proof-load tests as specified. This survey-and-design loop is the difference between a façade that installs itself and one that argues with every floor.

Step 2: Set out and fix the brackets

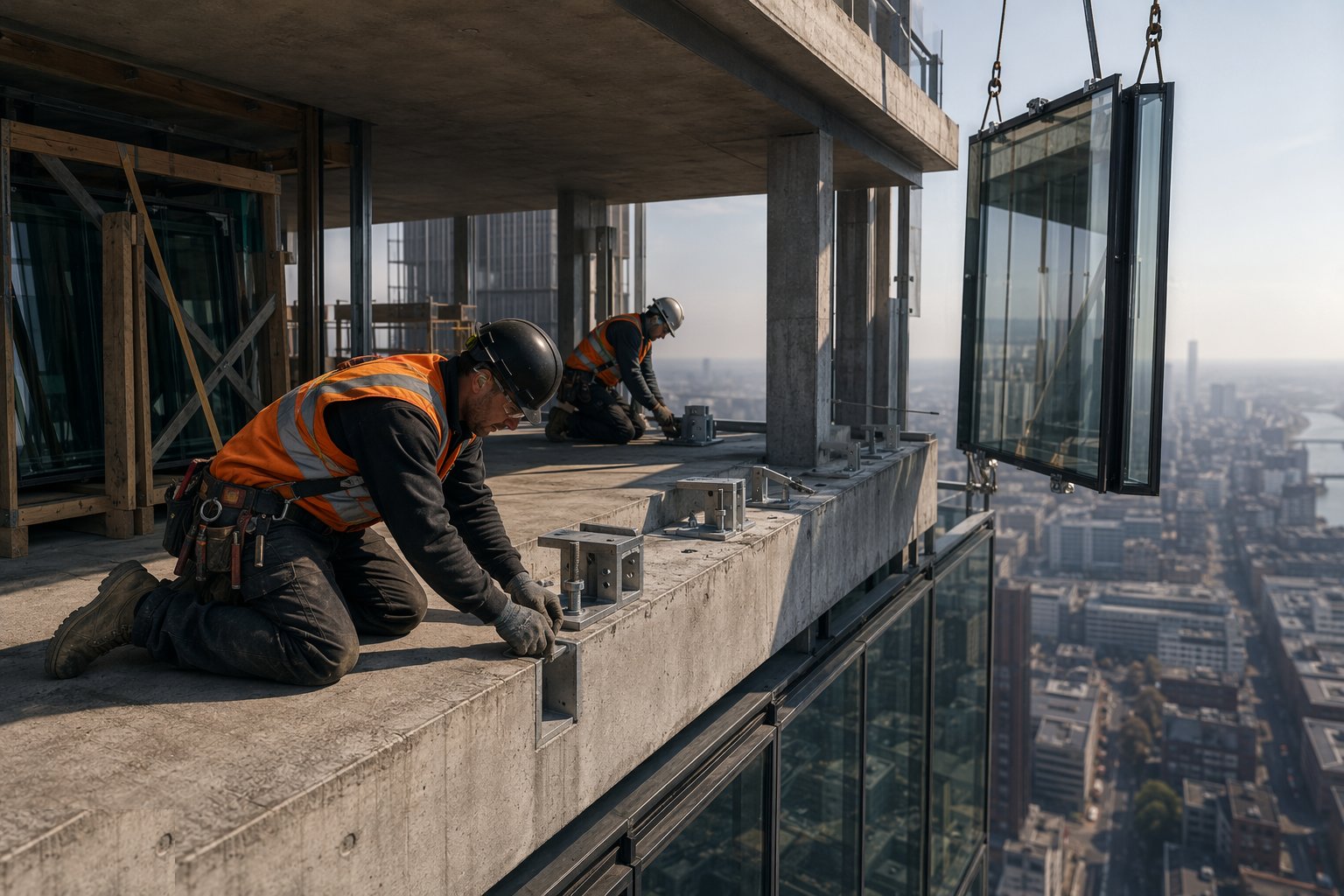

Set out and fix the brackets — Curtain Walling & Unitised Façades, step 2

Brackets are set to a surveyed line — string lines, laser or total station control between datum points — torqued, and inspected before panels arrive. Every anchor into concrete is installed per its approval: correct drill depth, cleaning, torque, and proof testing on the specified sample. The bracket is the façade's foundation and it gets foundation-level discipline: a systematic error here repeats every panel up the elevation, and the first ten brackets of each zone are checked like the whole building depends on them, because it does.

Step 3: Manage panel logistics: stillages, lifting and landing

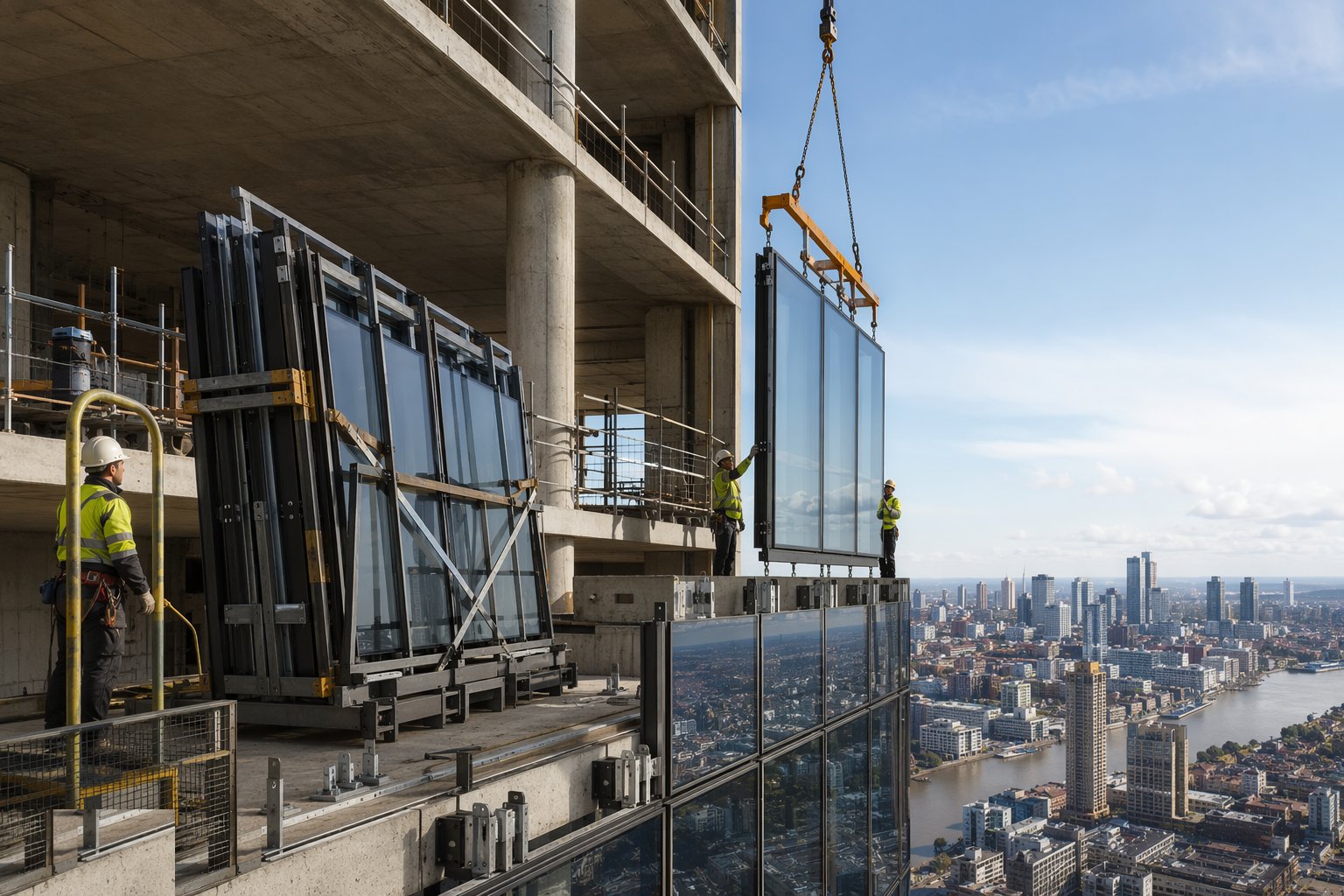

Manage panel logistics: stillages, lifting and landing — Curtain Walling & Unitised Façades, step 3

Panels arrive on stillages in installation sequence — the right panel for the right bay, because a unitised tower has no floor space to store wrong deliveries. Lifting is by tower crane with purpose-built lifting beams, or by monorail and mini-crane systems running at the slab edge that take panels inboard and walk them along the floor; MEWPs and façade access equipment serve the zones in between. Stillage returns, just-in-time deliveries and the daily hook-up count are managed like a production line: the factory is weeks away, and the sequence you install is the sequence you ordered months ago.

Step 4: Hook, align and interlock the panels

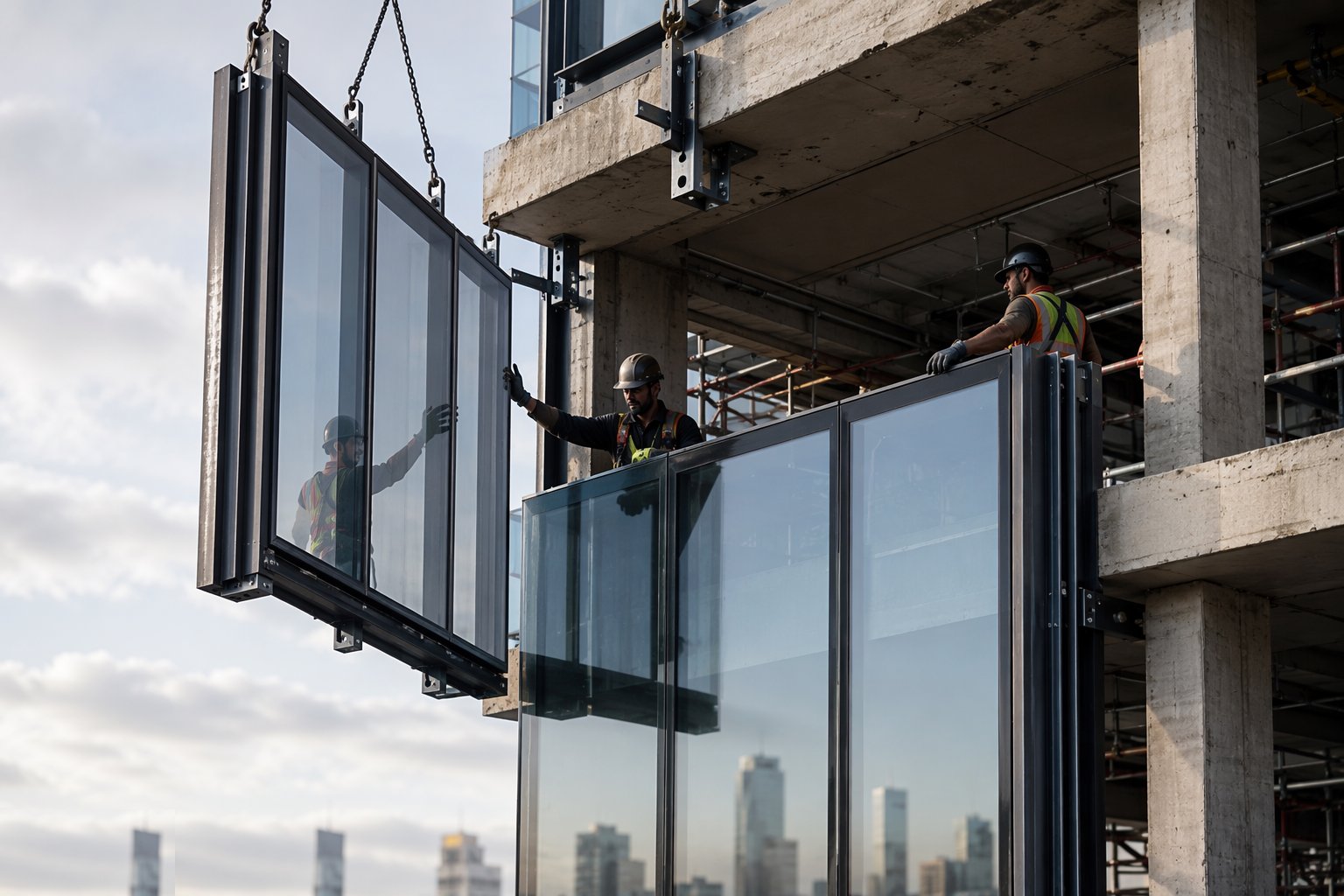

Hook, align and interlock the panels — Curtain Walling & Unitised Façades, step 4

Each panel is offered to its brackets, hooked on, levelled and aligned to its neighbours, and locked off — the gaskets at head, sill and jambs engaging to form the drained and ventilated joint system the performance depends on. Installers work from the floor edge or access equipment with the panel guided by tag lines; alignment is checked against the elevation control lines as each bay closes. The gasket joints are the weather seal: twisted, pinched or unseated gaskets are leaks scheduled for the first storm, and the inspection regime looks at joints, not at the glass.

Step 5: Close the perimeter: fire-stopping, cavity barriers and movement joints

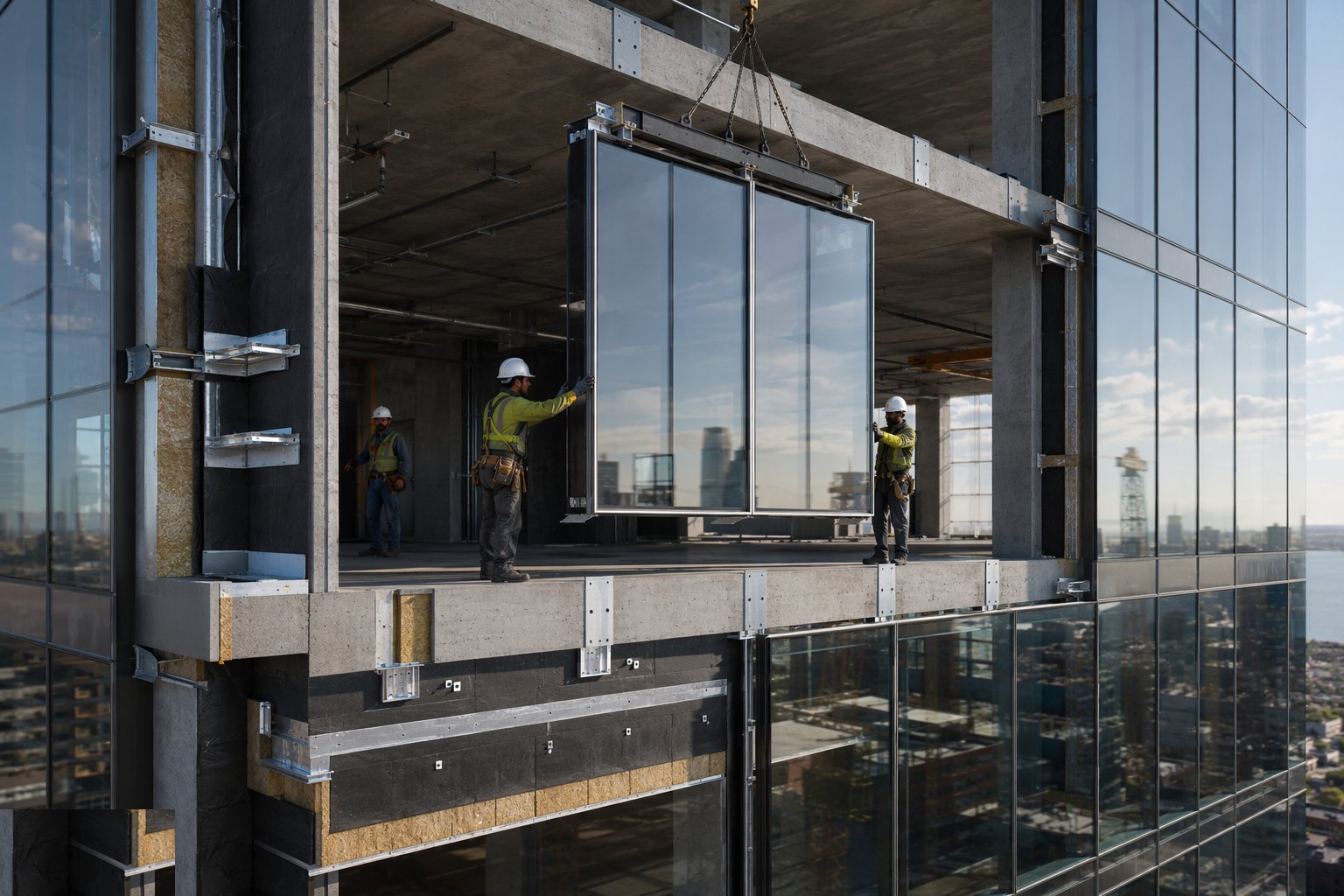

Close the perimeter: fire-stopping, cavity barriers and movement joints — Curtain Walling & Unitised Façades, step 5

The gap between slab edge and façade is closed with fire-stopping — mineral wool and tested seal systems to the compartmentation strategy, with cavity barriers at compartment lines and around openings exactly as the fire engineer's details demand. Movement joints are formed as detailed so frame sway, thermal movement and column shortening cannot rack the glazing. This zone is invisible at completion and critical in a fire; it is photographed, inspected and recorded panel line by panel line, because once the panel closes you will never see it again without a strip-out.

Step 6: Test: prototypes, site hose tests and surveys

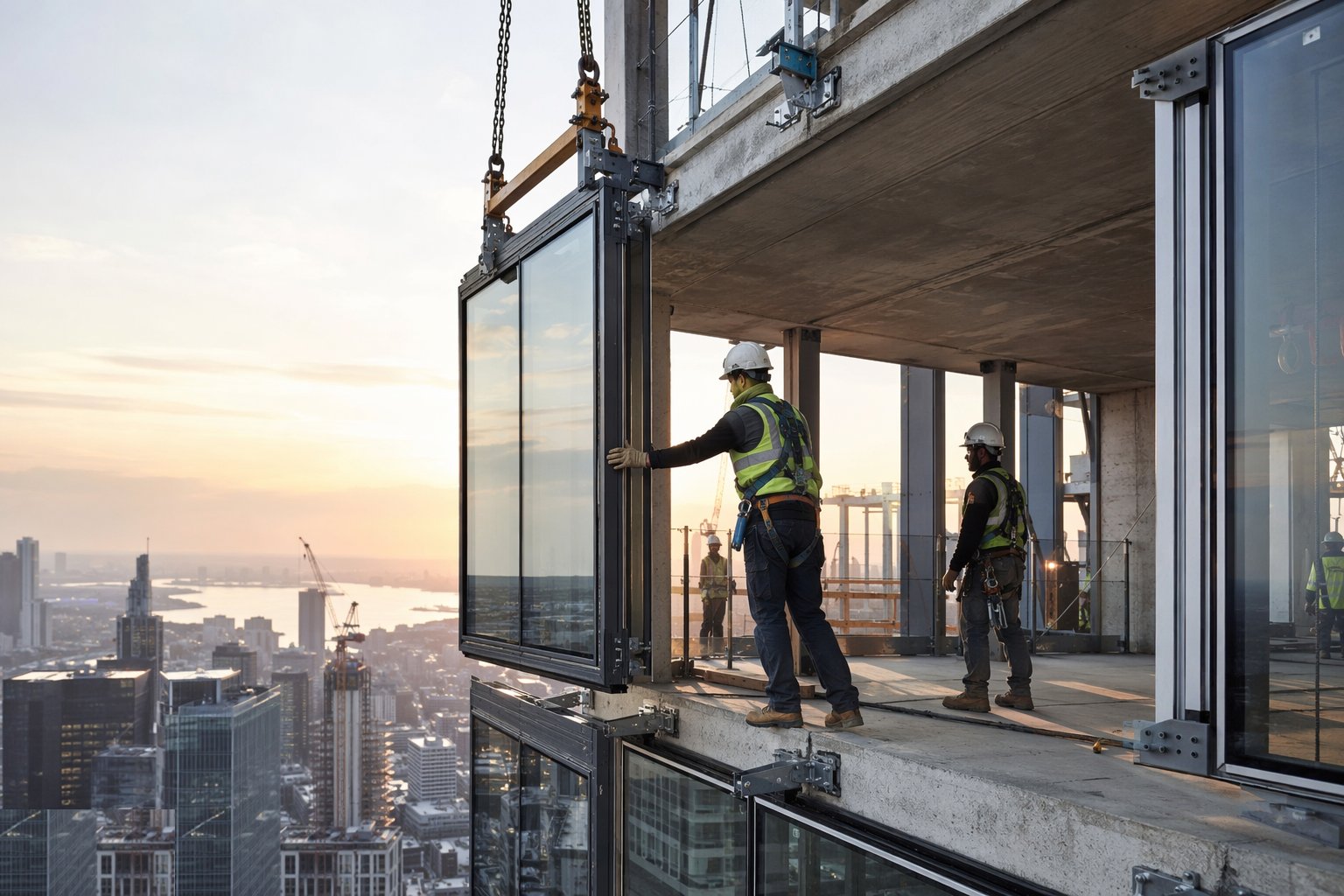

Test: prototypes, site hose tests and surveys — Curtain Walling & Unitised Façades, step 6

Performance is proven in layers. The system itself was prototype-tested — air leakage, static and dynamic water penetration, wind load and seismic or movement cycling to CWCT or ASTM/AAMA sequences — before manufacture. On site, sample areas are hose-tested to AAMA 501.2 or CWCT site methods: a calibrated nozzle, a defined spray pattern, and someone inside watching for the first drop. Failed areas are diagnosed and fixed before the fleet proceeds; gasket engagement, sealant joints and perimeter closures are the usual suspects. Final alignment surveys and an internal/external visual inspection close each zone, and the test records join the façade's evidence file.

Step 7: Clean, protect and hand over the envelope

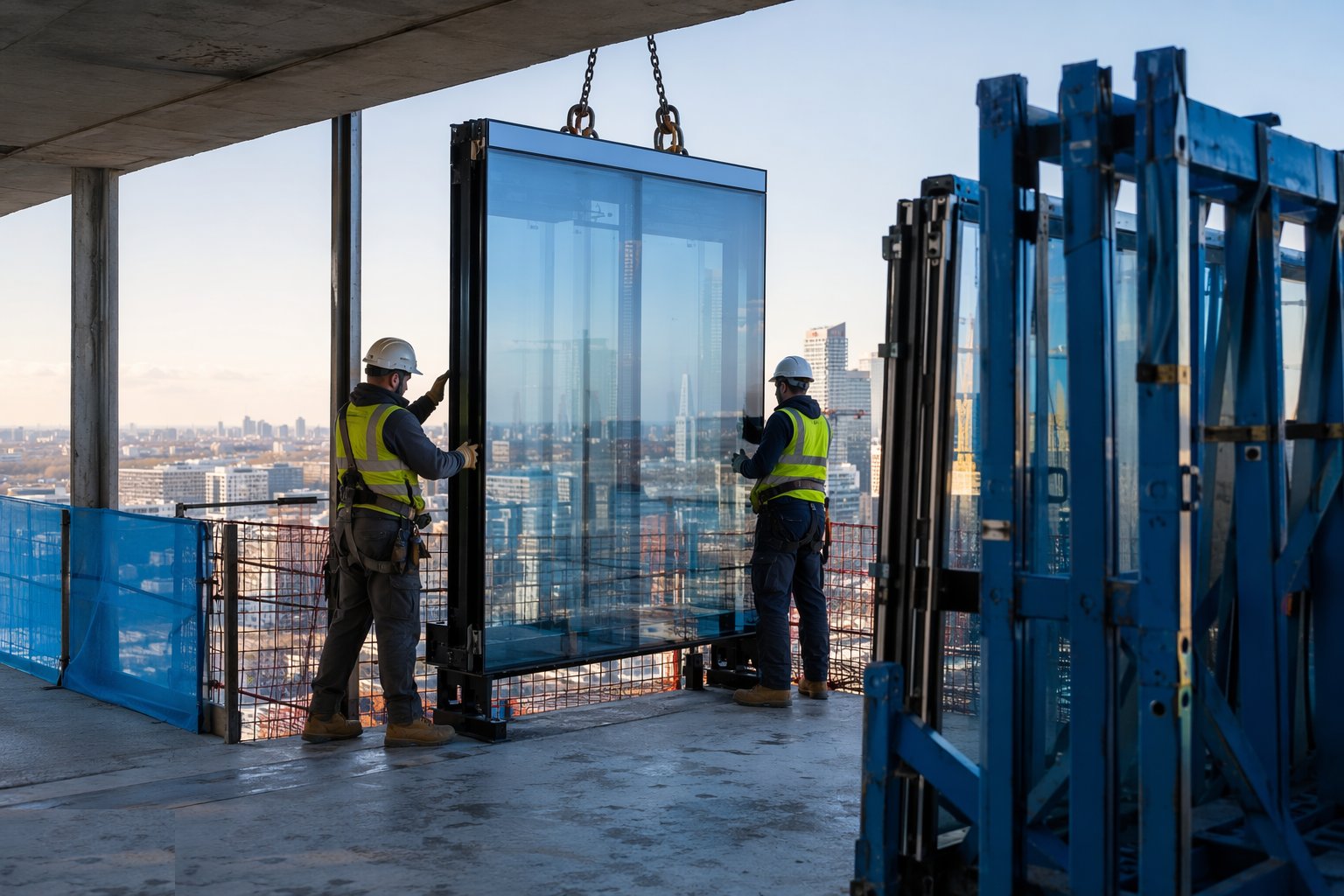

Clean, protect and hand over the envelope — Curtain Walling & Unitised Façades, step 7

Completed elevations are protected from the trades following behind — concrete splash, grinding sparks and weld spatter ruin glass irretrievably — and cleaned progressively so defects are seen early. Glazing is inspected for chips, scratches and edge damage, and any sealed unit showing misting or damage is recorded for replacement; heat-soaked toughened glass and solar-control coatings are handled per their own rules. Handover of the weathertight envelope zone by zone releases the internal trades, and the as-built bracket surveys, anchor test records, hose test results and the fire-stopping photographic file go into the façade package the building will rely on for decades.

Plant and equipment

Quality control checks

Safety considerations

Common defects

Best suited for

How long does Curtain Walling & Unitised Façades take?

Typical duration: A unitised elevation typically closes 8–15 panels per day per installation crew — a floor a week per face on a regular tower — with the full envelope of a 30-storey tower running 8–14 months from first bracket to final hose test, phased behind the frame..
