Precast Concrete Structures

Crosswall, twin-wall, hollowcore, stairs, lift shafts and sandwich panels — the factory-made concrete frame, and why the UAE builds this way by default.

Precast Concrete Structures — construction process cover

Last updated 2026-07-28 by the BuildPedia Editorial Team.

What is Precast Concrete Structures?

Precast concrete is the oldest and most successful MMC of them all, which is presumably why the MMC conversation keeps forgetting to include it. Walls, floors, stairs, lift shafts, columns, beams and façade panels are cast in a factory or yard under controlled conditions, cured properly, and craned into position where they are stitched together with in situ concrete, grout and reinforcement. The quality argument is settled: factory concrete has better finish, better cover control and better strength consistency than anything poured in the rain off the back of a mixer. The site stops being a concrete factory and becomes an assembly operation with a crane.

The systems divide by how much is precast. Crosswall construction uses loadbearing precast walls with hollowcore or solid precast floors — the classic hotel and residential-block system, fast and inherently fire- and sound-resistant. Twin-wall is the halfway house: two factory-cast leaves joined by lattice girders, craned into position and filled with in situ concrete to make a solid wall with the ties and laps already in it. Hollowcore planks span between walls or beams as floors with their cores doing duty as service routes and saving dead weight. Around them sit the components every site knows: precast stairs that land in minutes instead of a fortnight of formwork, lift-shaft modules, and insulated sandwich façade panels that are structure, insulation and architectural face in one pick.

Nowhere has taken this further than the UAE, where precast is not an MMC choice but the default. Villa walls across Dubai are precast panels standing on strip or raft foundations, hollowcore floors span the rooms, and the boundary wall of nearly every plot in the emirate is precast — an industry built on DM/DDA-approved standard designs, with the casting yards of Sharjah and Abu Dhabi feeding a supply chain that never stopped. There are hard reasons: the climate punishes site-cast concrete (48 °C afternoons, hot-weather concreting rules, curing that never quite happens on site), the labour model suits factory production over formwork carpentry on site, and repetition is total — a thousand villas of the same five types is a factory order book, not a design problem.

The trade-offs are the same everywhere. Precast is heavy, so craneage and transport are real costs and the design grid is set by what a lorry and a crane can handle. Connections — grouted sleeves, bolted plates, welded plates, dowelled hollowcore bearings — are engineered points in an otherwise monolithic material, and they demand the tolerance discipline that in situ work lets you fudge. And during erection the frame is a kit of parts held up by props and temporary bracing until the stitches gain strength: the stability case is a temporary-works design, not an assumption.

When and why is Precast Concrete Structures used?

Precast wins on repetition, programme and quality: residential blocks, hotels, student housing, car parks, prisons and anywhere the same bay repeats. Crosswall suits cellular plans where walls can carry load; twin-wall suits where cast in situ robustness is wanted without formwork; hollowcore floors span economically with few props. In the UAE it is the default for villas, boundary walls and much mid-rise work — DM/DDA-approved standard systems, factory quality in a climate hostile to site concrete, and a mature yard supply chain. It loses on one-off geometry, heavy transfer structures, sites with no crane standing, and designs that are still moving after the moulds are ordered.

Types of Precast Concrete Structures

Crosswall frames

Loadbearing precast concrete walls at room-width centres carrying hollowcore or solid precast floors. The hotel, student-block and residential system: monolithic once stitched, excellent fire and sound performance, very fast per floor.

Twin-wall systems

Two precast leaves joined by lattice girders, erected and filled with in situ concrete — factory accuracy and finish with a monolithic core. Walls go up without formwork; the fill pour ties walls, floors and stitches into one structure.

Hollowcore floors and stairs

Prestressed hollowcore planks spanning 6–12 m between supports, grouted at joints, with precast stair flights and landings craned in per storey. The workhorses of precast: fast, soffit-flat, minimal propping.

Sandwich façade panels and lift shafts

Insulated sandwich panels — structural inner leaf, insulation core, architectural outer face — hung on the frame as the finished envelope in one pick; plus precast lift-shaft modules stacked like blocks. Cladding and core solved as products, not trades.

Precast Concrete Structures: step by step

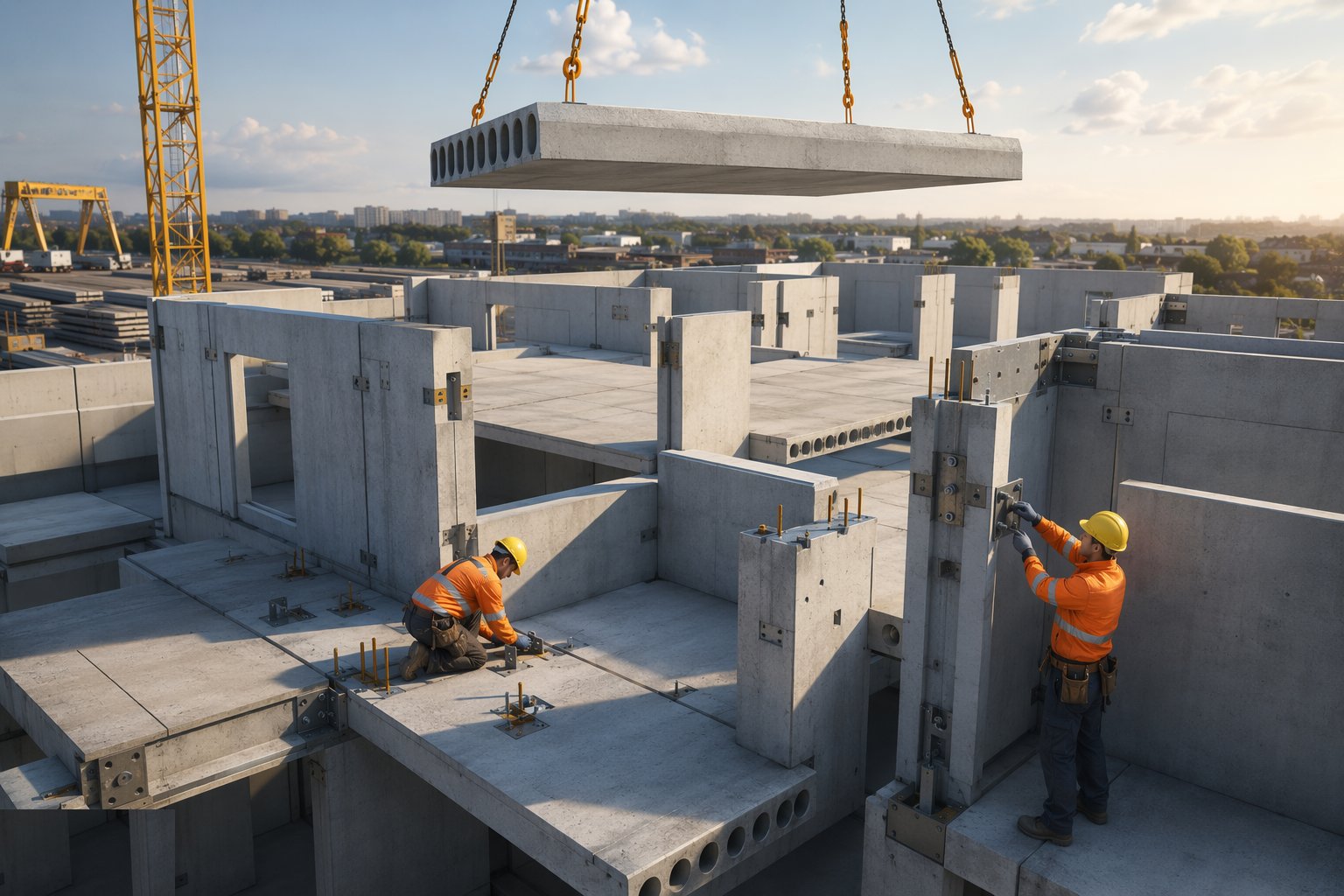

Step 1: Fix the grid, the tolerances and the connection design

Fix the grid, the tolerances and the connection design — Precast Concrete Structures, step 1

Precast design locks early: the structural grid, panel sizes within transport and crane limits, bearing lengths, and every connection detail — grouted sleeves, dowels, bolted or welded plates, hollowcore bearing strips. Tolerances are allocated across the chain (foundation, unit, erection) so they do not stack up at the worst joint. In the UAE this stage runs through DM/DDA or Trakhees approval of the precast system and shop drawings before the moulds are touched.

Step 2: Cast and cure in the yard, with QC the site cannot match

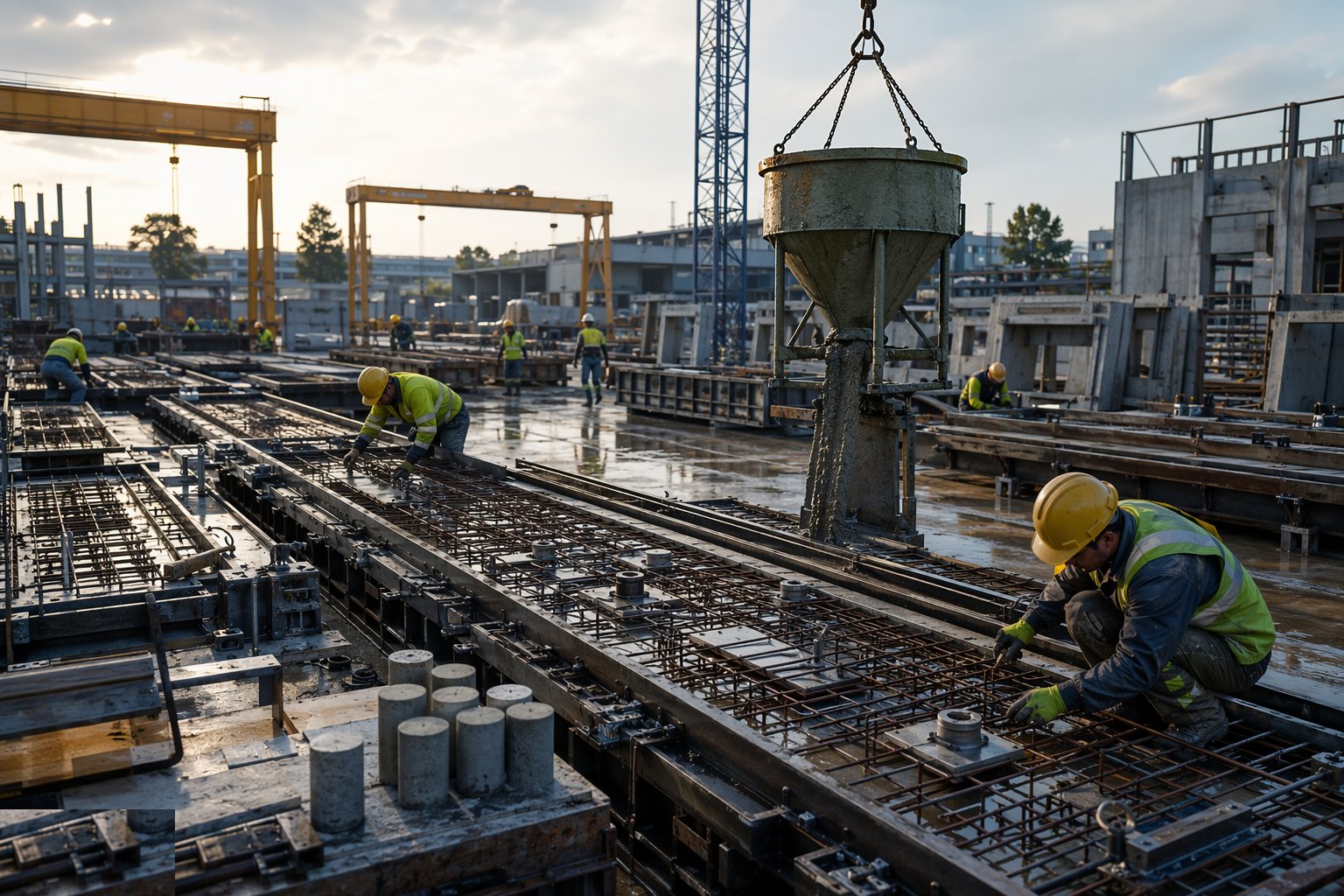

Cast and cure in the yard, with QC the site cannot match — Precast Concrete Structures, step 2

In the casting yard, reinforcement and cast-in items — lifters, sleeves, connection bars, plates — are fixed in the moulds, inspected, and concreted under controlled batching with cube or cylinder sets per cast. Curing is managed (steam or controlled heat in many yards), demould times follow strength results, and every unit is marked, dimension-checked and logged before it leaves the bed. The paper trail per unit — cast date, results, mark — is what the site will demand when a panel looks wrong.

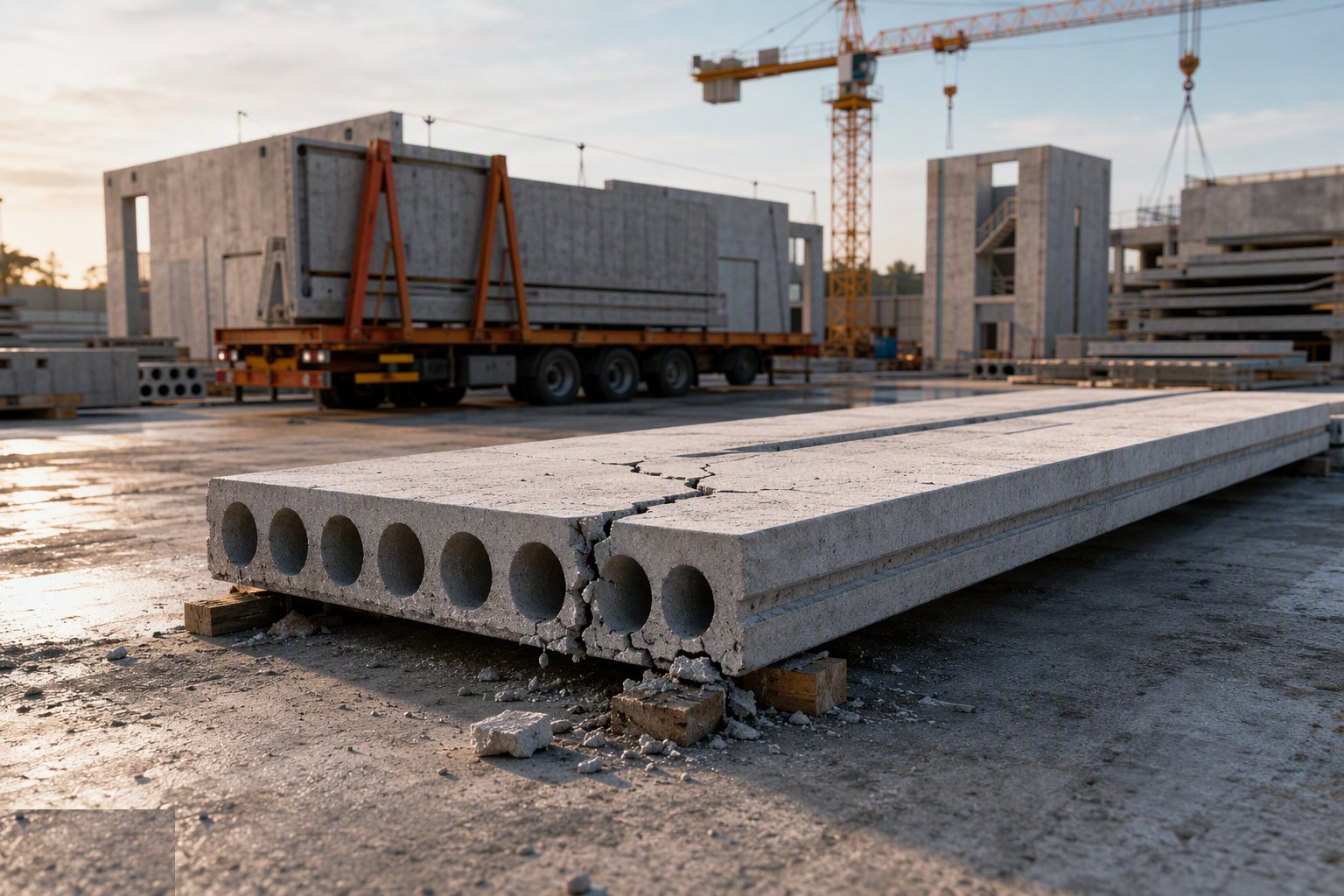

Step 3: Transport, stack and sequence the deliveries

Transport, stack and sequence the deliveries — Precast Concrete Structures, step 3

Units travel on A-frames and flatbeds in erection order, supported at their designed points — a hollowcore plank stored on the wrong bearers cracks before anyone lifts it. The site stacks on level, firm ground with bearers aligned vertically through the stack, and the delivery schedule is matched to the crane: just-in-time is the aim because a site full of stacked panels is a handling accident and a wind-load problem waiting to happen.

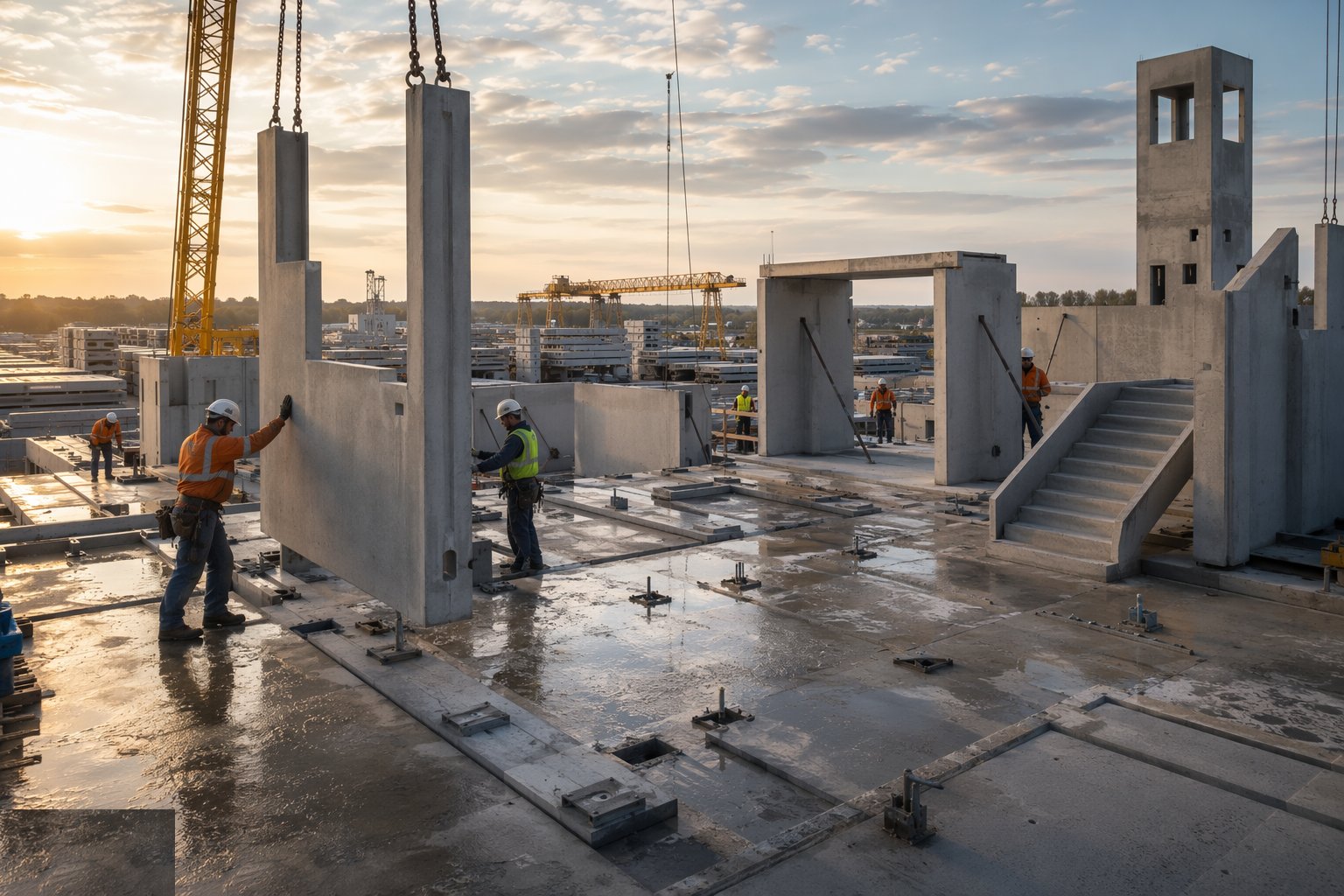

Step 4: Set out, level the bearings and start the walls

Set out, level the bearings and start the walls — Precast Concrete Structures, step 4

Foundation or slab bearings are surveyed to the erection tolerance — level pads, grout beds or shims per the detail — and wall panels are lifted on their designed anchors, set to line, plumbed and braced or propped immediately. The first panels establish the grid truth for the whole floor; connections to starters and sleeves are made as each panel lands, not in a batch later.

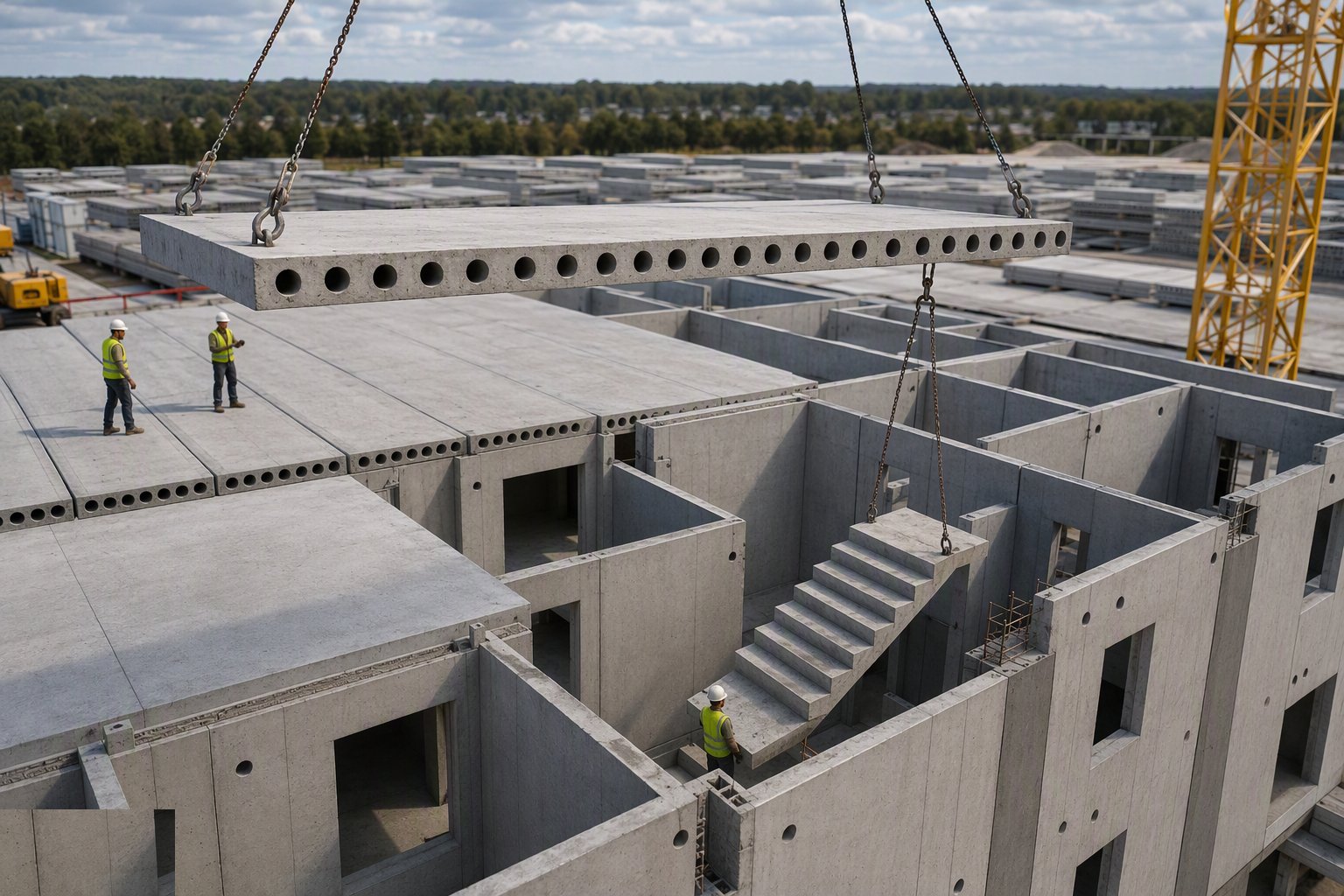

Step 5: Land floors, stairs and shafts on the wall plates

Land floors, stairs and shafts on the wall plates — Precast Concrete Structures, step 5

Hollowcore planks land on their bearing strips with the specified bearing length, jointed and grouted; precast stairs drop between landing levels in minutes with their bearings and ties made; lift-shaft modules stack with their inter-unit connections. Propping goes in where the design calls for it — planks carrying construction load, edge conditions, twin-wall awaiting its fill — and stays until the stitch concrete has the strength, not until the programme wants it gone.

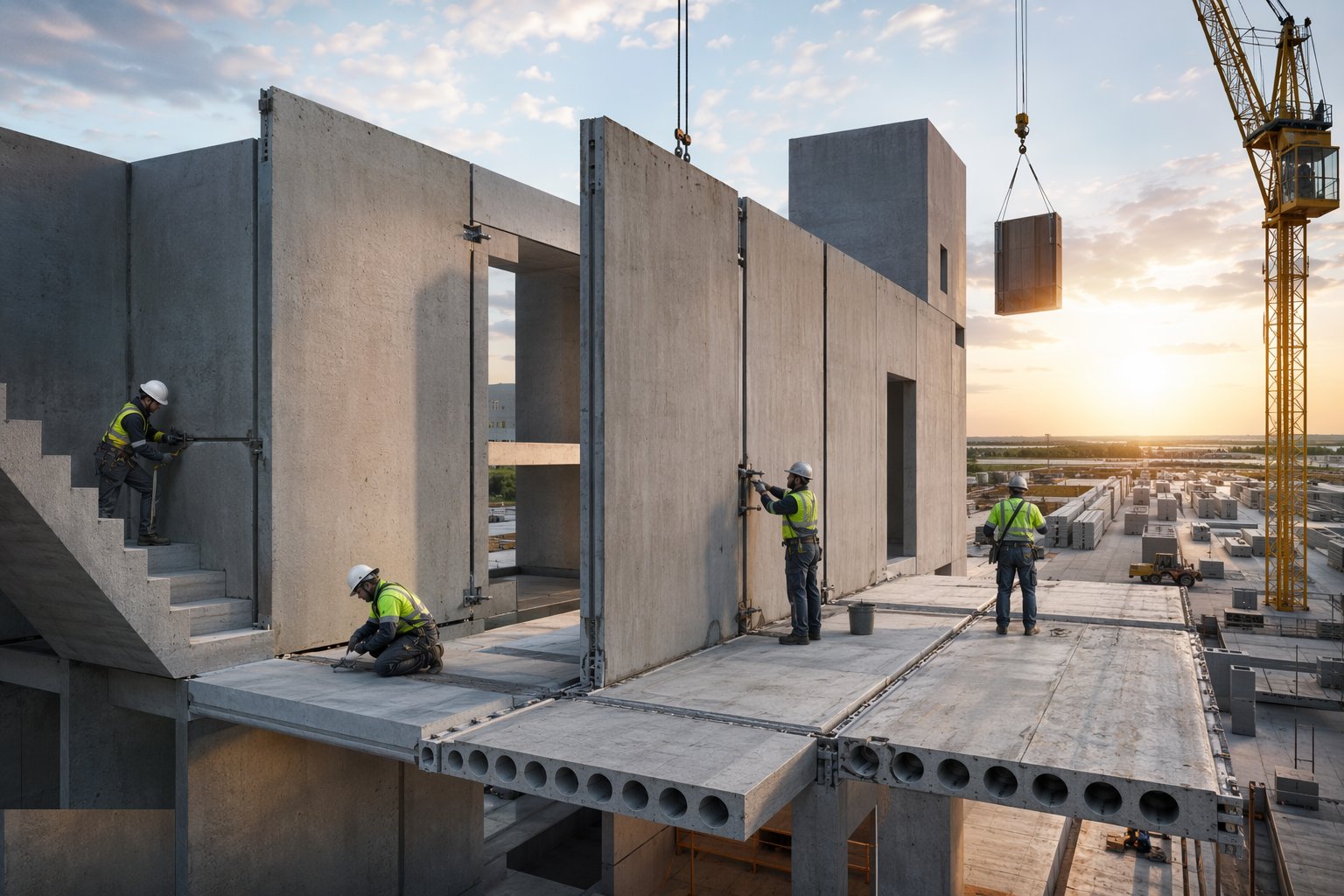

Step 6: Make the connections — grout, bolts, welds and stitches

Make the connections — grout, bolts, welds and stitches — Precast Concrete Structures, step 6

This is the structural heart of the method. Grouted sleeve and dowel connections are filled with the specified non-shrink grout, flowed and vented properly, with test cubes; bolted and welded plate connections are torqued or welded to procedure and inspected; in situ stitch concrete between walls and floors is placed, vibrated and cured. Twin-wall gets its core fill in controlled lifts. Every hidden connection is photographed and recorded before the next unit buries it.

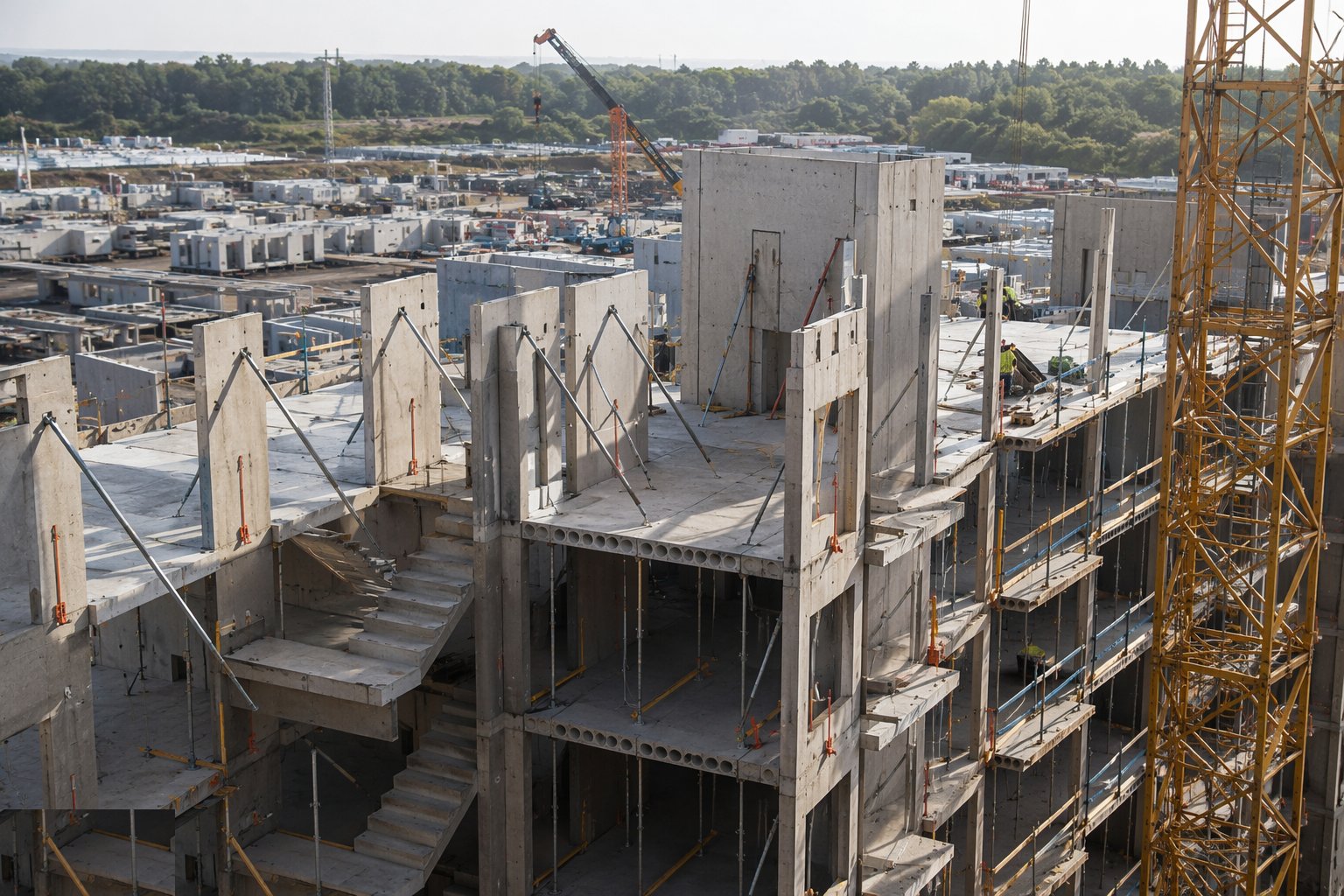

Step 7: Hold stability through the temporary-works design

Hold stability through the temporary-works design — Precast Concrete Structures, step 7

Until the stitches and fills reach strength, the building stands on its temporary works: panel braces, floor props, hold-downs and the erection sequence itself. The temporary-works designer owns the stability case — wind on unbraced panels, incomplete diaphragms, crane loads on part-strength floors — and the site does not strike a prop or load a floor without the strength evidence. Most precast collapses worldwide happen in exactly this window.

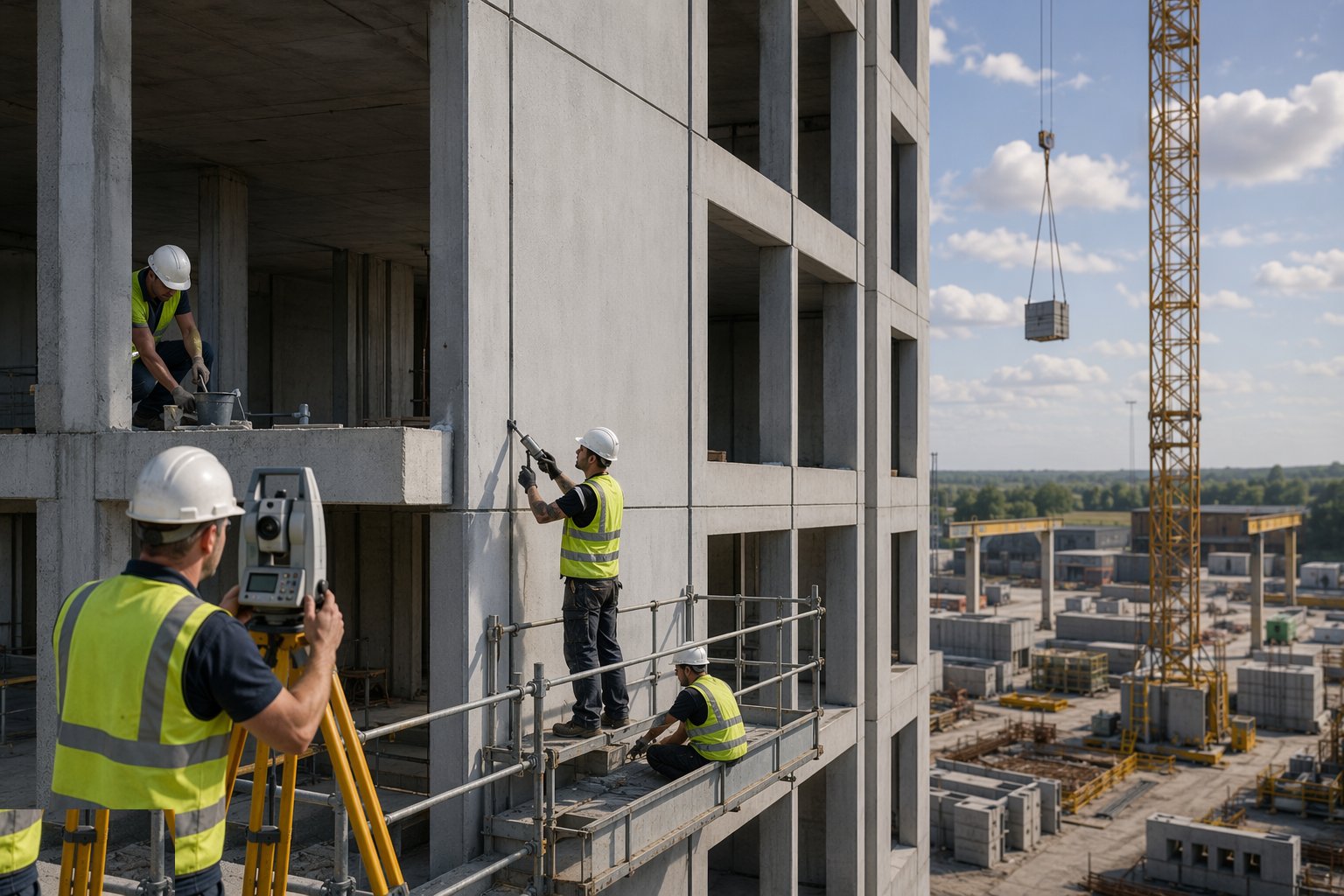

Step 8: Survey, seal the joints and hand the structure over

Survey, seal the joints and hand the structure over — Precast Concrete Structures, step 8

As-built survey records line, level and plumb per floor; joints between façade panels are sealed with the specified system; bearing and joint grouts are checked for fill. The structure hands over to follow-on trades with cast-in channels, plates and sleeves exactly where the drawings put them — which is the last discipline of precast: there is no chasing a concrete wall that was finished in a factory, so first fix works to the cast-in schedule or not at all.

Plant and equipment

Quality control checks

Safety considerations

Common defects

Best suited for

How long does Precast Concrete Structures take?

Typical duration: A precast frame floor cycle: 1–2 weeks per storey once running, against 3–4 for cast in situ. A UAE villa wall set erects in days with the yard lead time (typically 4–8 weeks) upstream. The movers: unit count, crane count and radius, connection complexity, and curing time on the stitches before props come out..
