Concrete Frame Construction

Columns, walls and slabs cast in situ — the ribcage of a residential tower.

Concrete Frame Construction — construction process cover

Last updated 2026-07-28 by the BuildPedia Editorial Team.

What is Concrete Frame Construction?

The reinforced concrete frame is the dominant structure for apartment blocks and residential towers: flat slabs on columns, stabilised by shear walls and cores, cast floor by floor in a weekly rhythm. Its virtues are robustness, fire resistance, acoustic mass and the ability to build tall with local skills. Its demands are discipline — every floor repeats, and every repeated mistake repeats with it. In the Gulf it is simply the vernacular: villas and towers alike are overwhelmingly reinforced concrete frames, with post-tensioned slabs common in towers.

Frame construction is a logistics exercise as much as an engineering one. The tower crane cycle time sets the heartbeat: formwork up, reinforcement fixed, concrete poured, cured, struck, and the formwork flies again. A well-run frame gains a floor every five to ten working days, and that rhythm is made or lost in the planning of pours, the quality of the formwork and the reliability of the concrete supply.

When and why is Concrete Frame Construction used?

Frame construction follows the substructure and continues until the building tops out, with follow-on trades chasing it floor by floor. Concrete frames are chosen for residential towers and blocks where acoustic separation, fire compartmentation and floor stiffness matter, and where a repeated floor plate rewards systemised formwork. The process matters because the frame is the building: geometry errors, cover failures and early striking are inherited by every trade that follows. At the small end the same trade builds a Gulf villa frame or a basement box for a house extension: the pours shrink to a few mixer loads and the table forms become timber shuttering, but cover, compaction, curing and striking-by-strength are exactly as unforgiving.

Types of Concrete Frame Construction

Flat slab frames

Slabs of constant thickness spanning directly to columns, with drops or hidden column heads where punching shear demands. Fast formwork, clear soffits for services, and flexible partitions — the default for residential frames. Punching shear design and deflection control are the engineering watchpoints.

Beam and slab frames

Slabs spanning to beams, beams to columns — more formwork labour but better stiffness, longer spans and simpler punching checks. Common where spans are large, loads are heavy, or the transfer of loads at podium level demands deep structure.

Shear walls and cores

Concrete walls around stairs and lifts that carry vertical load and — critically — all the lateral wind and stability load. Cores often lead the frame by several floors, built with jump form or slip form rigs that climb as they pour. Wall verticality controls the whole building's plumb.

Post-tensioned slabs

High-strength tendons tensioned after the concrete gains strength compress the slab, allowing thinner sections and longer spans. Efficient and common on larger plates, but the stressing operation, the grouting and the future "do not drill" legacy demand rigorous records and marking.

Concrete Frame Construction: step by step

Step 1: Plan the pour sequence and the cycle

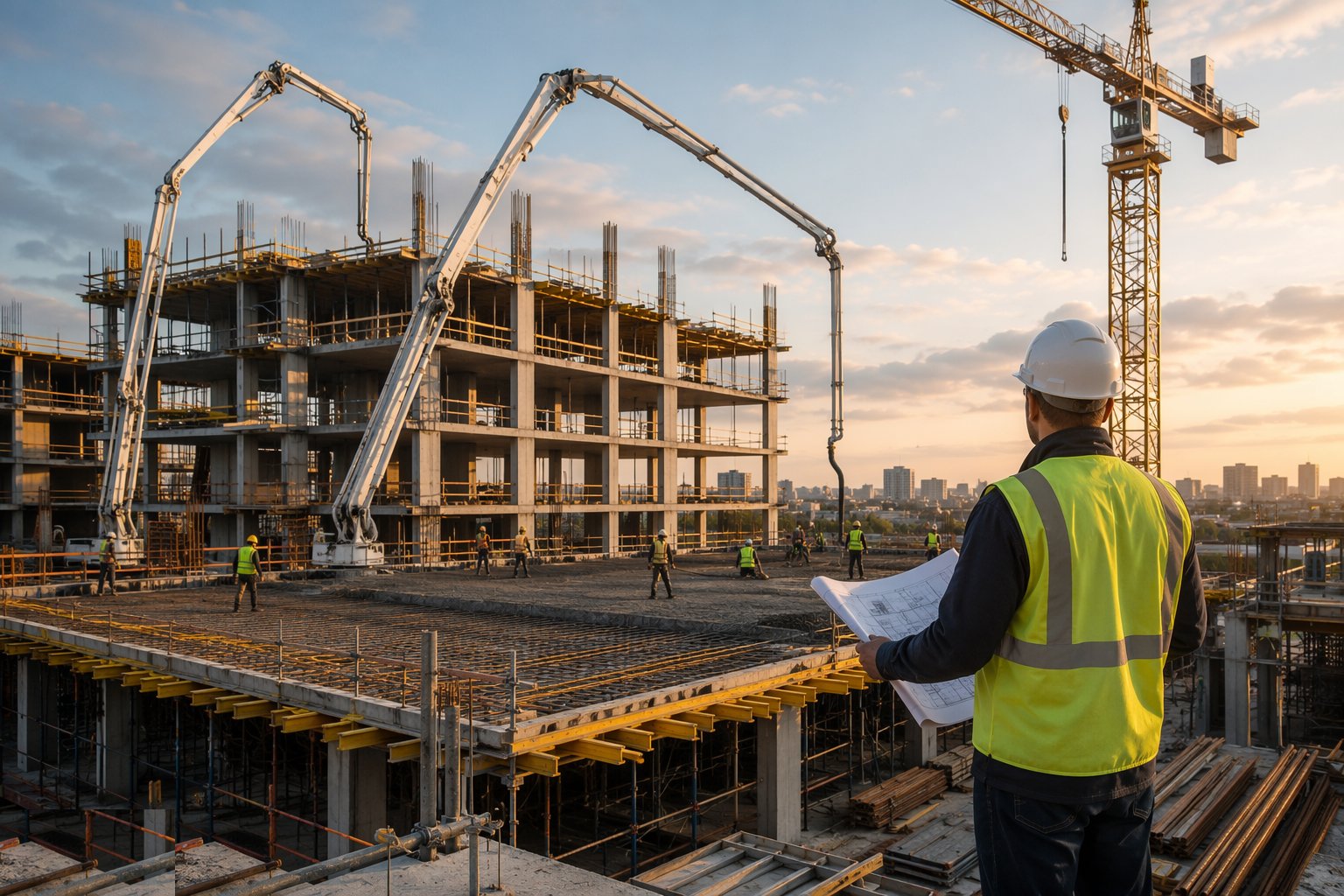

Plan the pour sequence and the cycle — Concrete Frame Construction, step 1

Break each floor into pours matched to concrete supply, gang size and curing capacity — a floor plate might be two or three pours with planned construction joints at the design positions. Map the crane cycles: formwork, reinforcement, concrete skips, back-propping materials. The weekly cycle is rehearsed on the first typical floor and refined from there.

Step 2: Erect formwork and falsework

Erect formwork and falsework — Concrete Frame Construction, step 2

Table forms are flown in by crane and set level on the floor below, which is itself propped back through as many floors as the design demands — the wet weight of a fresh slab plus construction loads regularly exceeds the design imposed load of the floors below, so the back-propping count comes from the temporary works design, not habit. Wall and column forms are set plumb from the grid lines, with kickers cast or scribed for level. Form faces are cleaned and oiled; the finish you see is the finish the mould had.

Step 3: Fix reinforcement

Fix reinforcement — Concrete Frame Construction, step 3

Mesh and bar — reinforcement to BS 4449, scheduled and bent to BS 8666 — are fixed to the bending schedule with correct laps, anchorage and cover: top mat on chairs at slab thickness, column links at the specified pitch, and punching shear reinforcement around columns where designed. Every bar bent on site to fit is a red flag: check the schedule before forcing the steel. Concealed-fix inspections are signed off before the pour releases.

Step 4: Set out cast-in items and openings

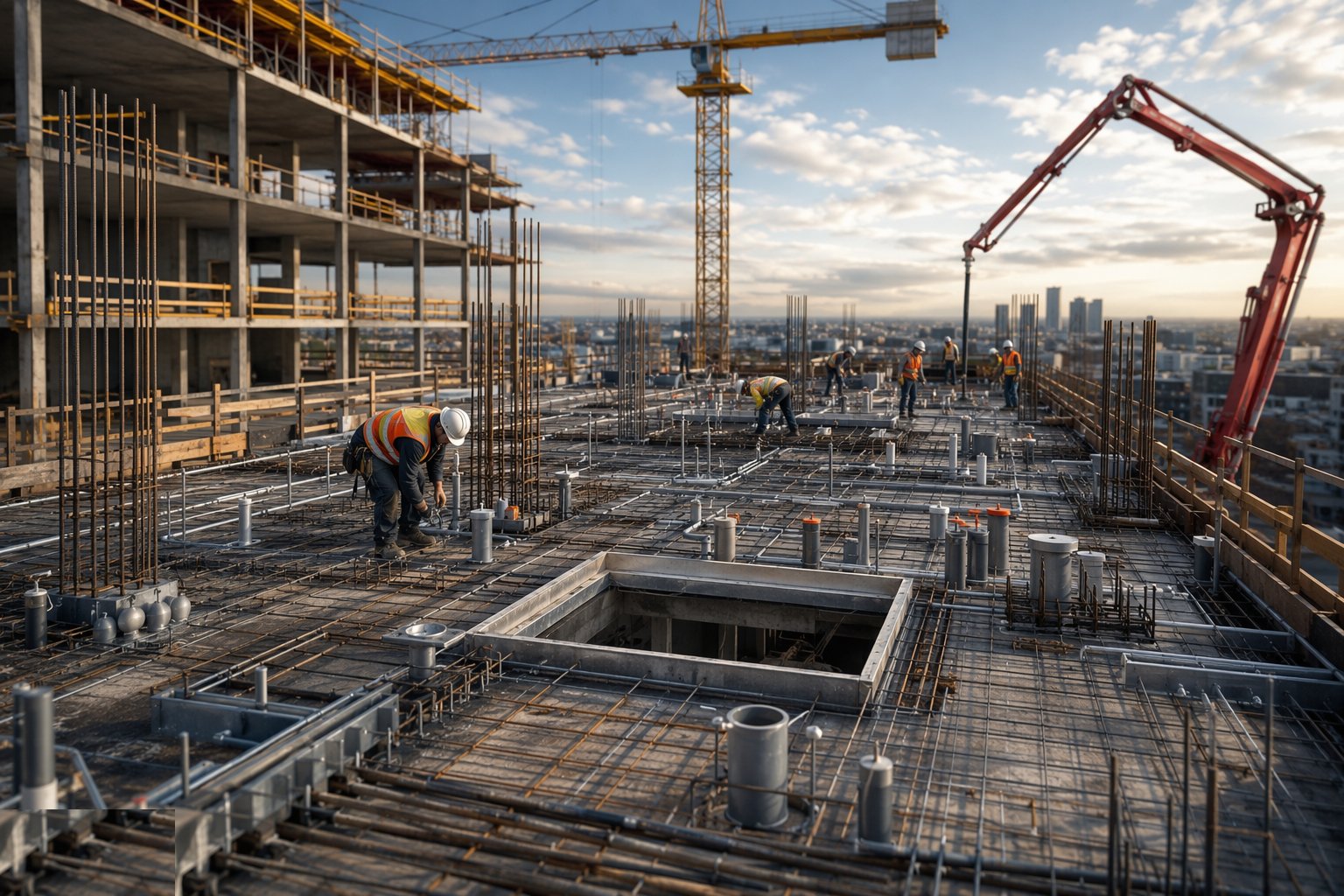

Set out cast-in items and openings — Concrete Frame Construction, step 4

Sleeves for services, box-outs for risers, edge trim, cast-in channels, lifting points and earthing are all fixed to the formwork before concrete — drilled and chased later is slower, weaker and usually in the wrong place. A services-coordination drawing walkdown on the fixed form catches the clashes while they are still cheap.

Step 5: Pour and compact the concrete

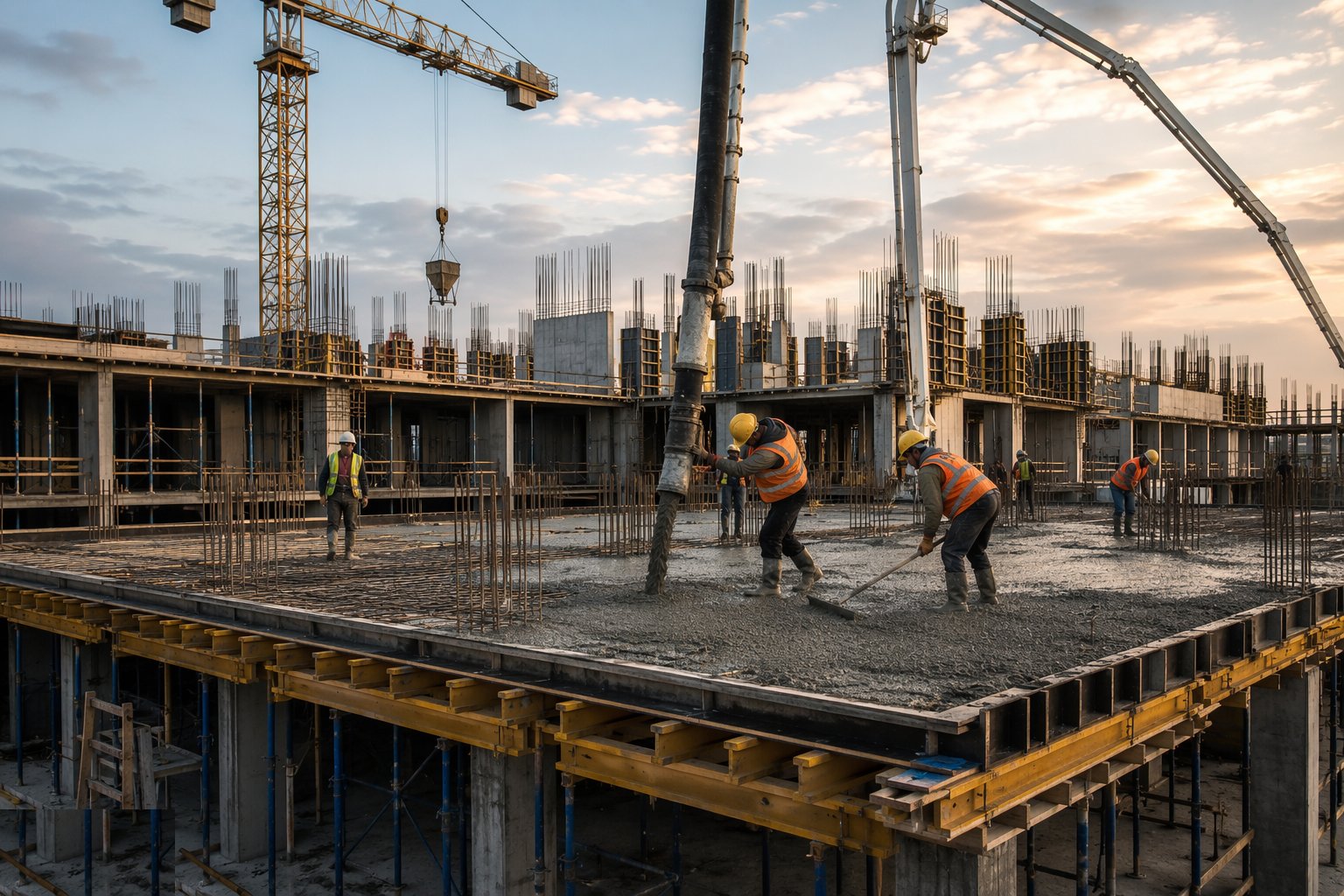

Pour and compact the concrete — Concrete Frame Construction, step 5

Concrete arrives by pump and placing boom or by crane skip; each load is slump-tested against the order and cubes are taken per the sampling plan. Place in layers, vibrate thoroughly — especially at column bases, wall kickers and around congestion — and never add water at the pump. Screed slabs to level with laser guides; the flatness of this floor is the ceiling quality of the one below. In Gulf summer the rules tighten: chilled mix water or flaked ice to bring concrete to site near 25 °C so placed concrete stays at or below about 35 °C, no retempering with water — workability comes from proven superplasticisers — and cement content typically capped around 450 kg/m³.

Step 6: Cure and protect

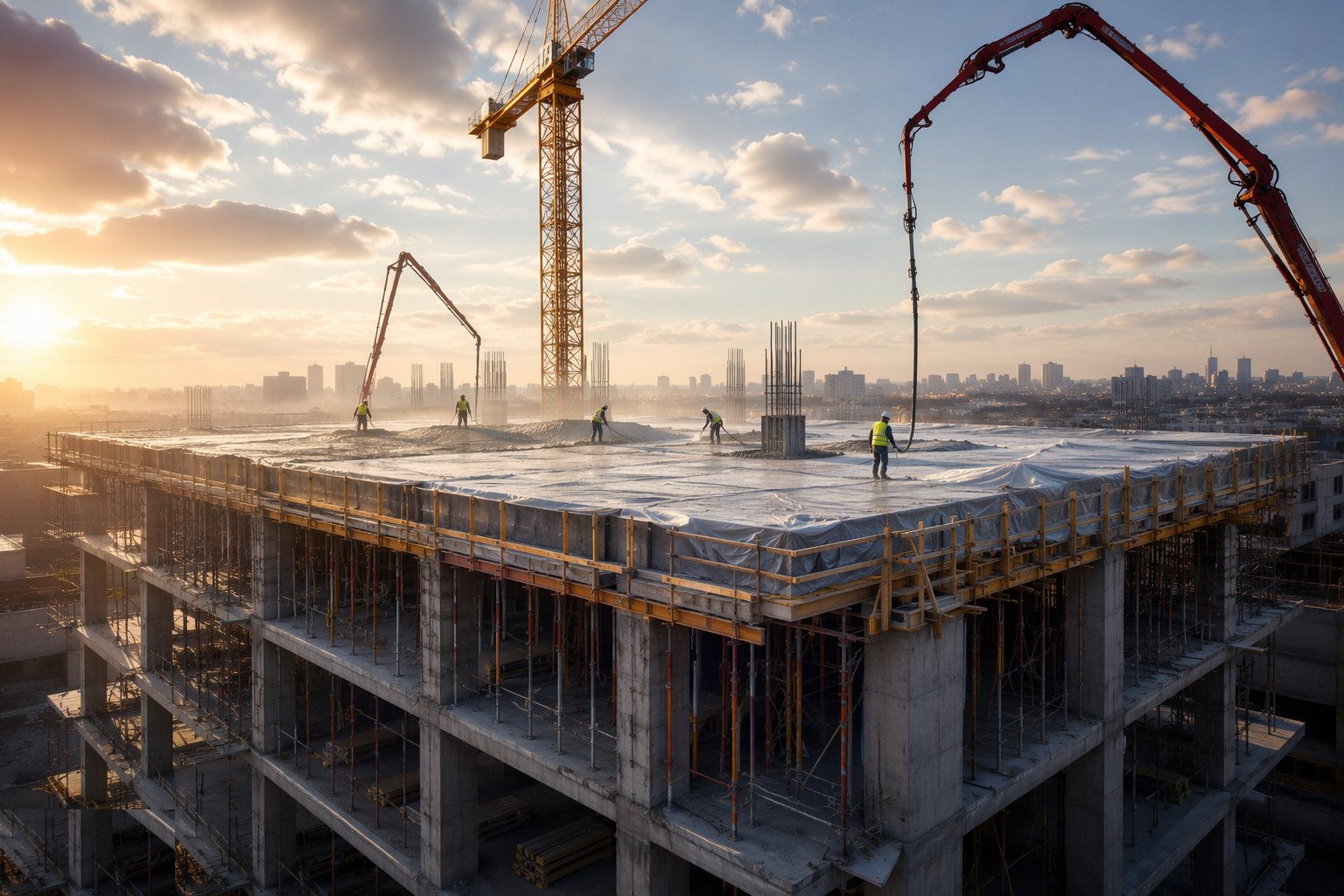

Cure and protect — Concrete Frame Construction, step 6

Curing starts as soon as the surface allows: sprayed curing compound, hessian and water, or polythene — hydration without moisture is strength left on the table. Fresh slabs are protected from rain, frost and foot traffic with the finish marked off-limits. In cold weather the pour is managed against predicted temperatures; in hot weather against plastic cracking.

Step 7: Strike formwork at proven strength

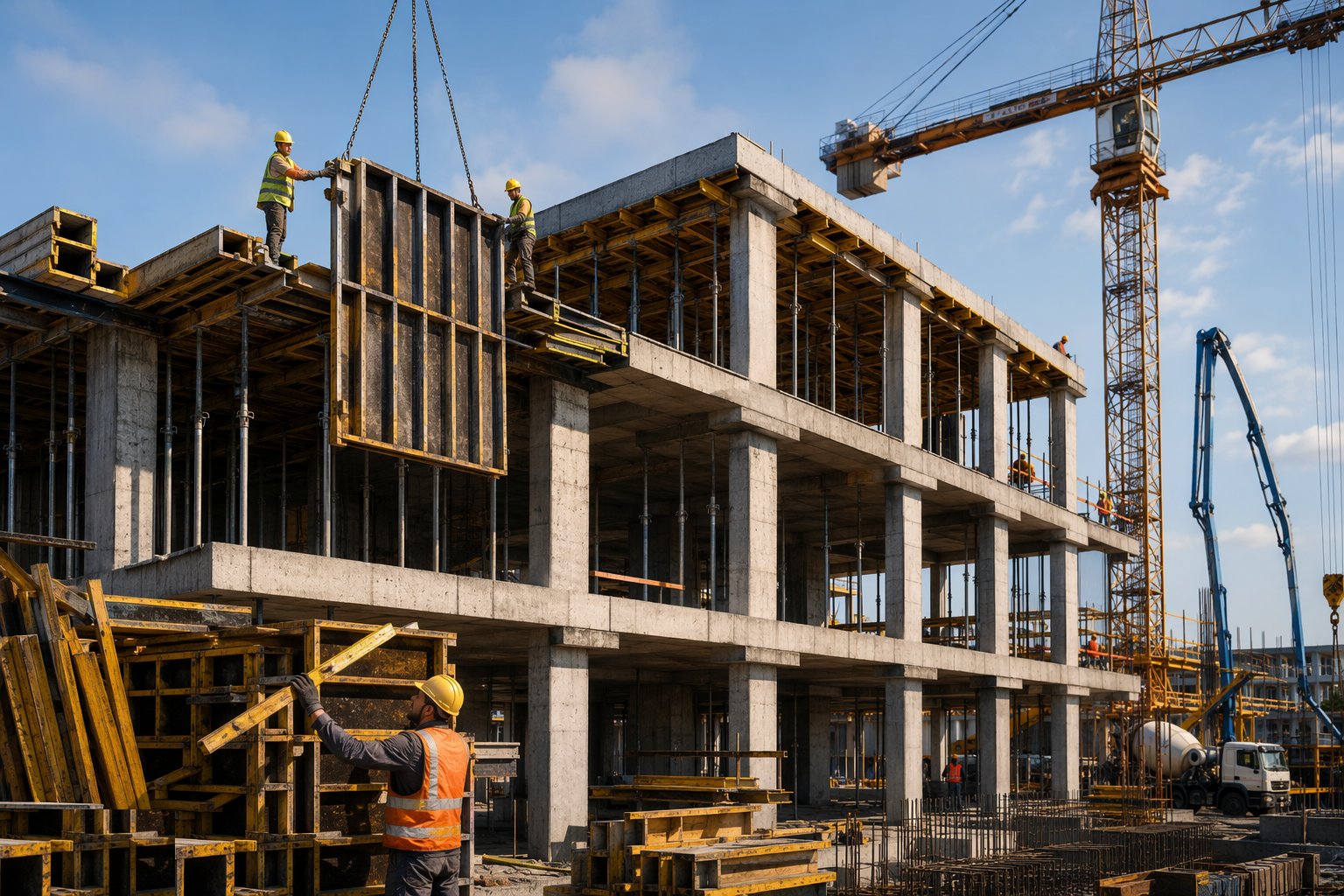

Strike formwork at proven strength — Concrete Frame Construction, step 7

Striking times come from the specification and are verified with cubes cured alongside the structure — not by the calendar alone. Slab soffits and props typically need the concrete at a specified proportion of design strength; the back-propping schedule below the new slab is part of the temporary works design. Premature striking shows up months later as sagging floors and cracked partitions.

Step 8: Stress post-tensioning where designed

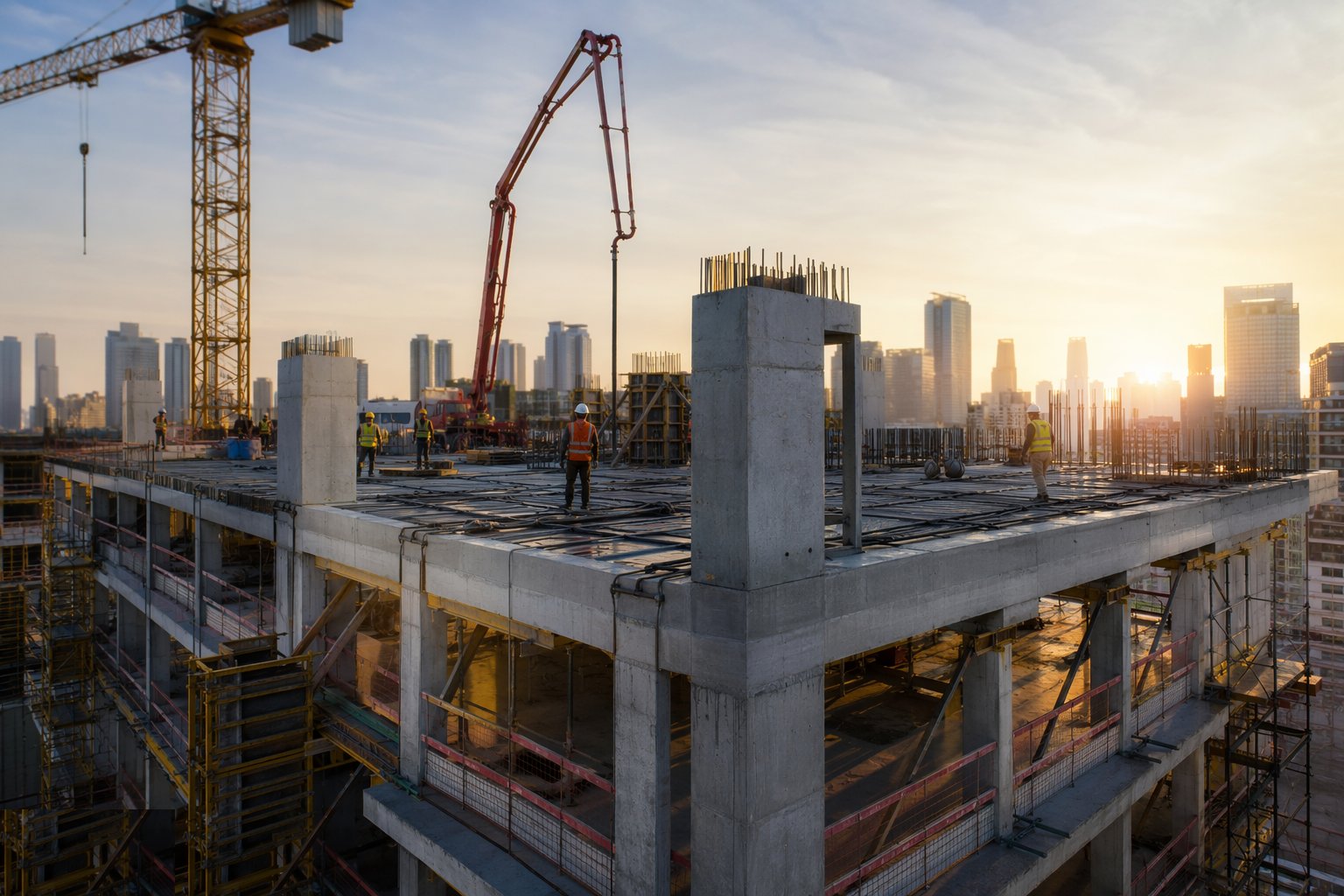

Stress post-tensioning where designed — Concrete Frame Construction, step 8

At the specified concrete strength, tendons are stressed to the calculated force and elongation — both measured, because force without matching extension means a blocked or broken duct. Anchorages are grouted and pockets made good. Stressing records become part of the structure's permanent file, and PT zones are marked for every future trade.

Step 9: Survey, record and cycle up

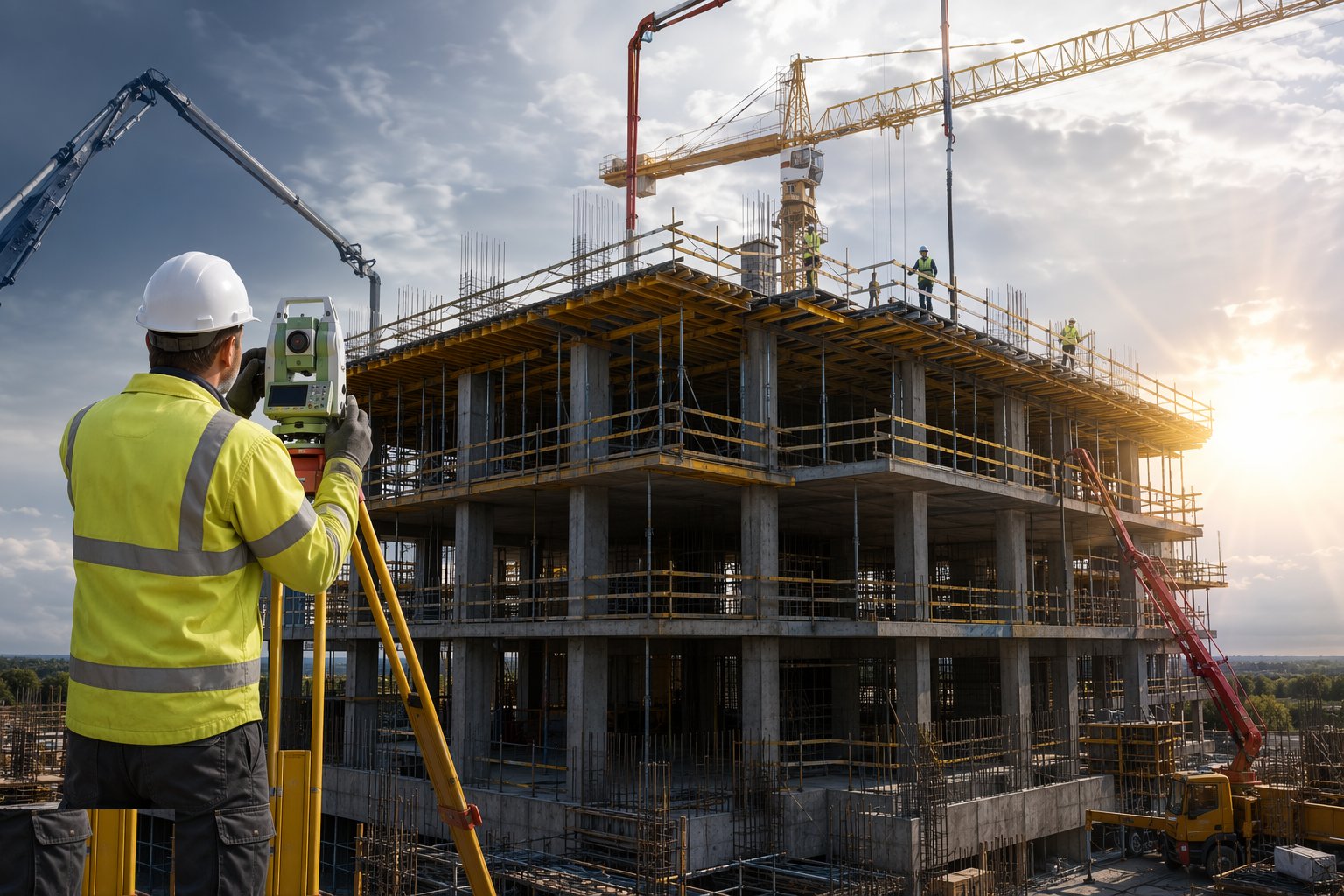

Survey, record and cycle up — Concrete Frame Construction, step 9

As each floor completes, the grid is re-established, levels are transferred and verticality is checked against the datum below. Non-conformances — honeycombing, cover issues, misaligned cast-ins — are repaired and recorded before the next pour hides the evidence. Then the tables fly, and the floor above begins.

Plant and equipment

Quality control checks

Safety considerations

Common defects

Best suited for

How long does Concrete Frame Construction take?

Typical duration: 5–10 working days per typical floor cycle; a 20-storey frame runs 6–12 months to top-out..
