Shallow Foundations

Strips, pads and rafts — spreading the building's weight onto good ground near the surface.

Shallow Foundations — construction process cover

Last updated 2026-07-28 by the BuildPedia Editorial Team.

What is Shallow Foundations?

Where decent bearing ground exists within a metre or two of the surface, shallow foundations are the economical answer: simple excavations, concrete, and reinforcement where the loads demand it. Most houses and low-rise buildings in the country stand on strip foundations a few hundred millimetres deep — a detail so standard it looks trivial, right up until the ground turns out not to be standard.

The engineering is in the ground verification and the detailing, within the framework of BS 8004 and Eurocode 7. The foundation width comes from the load divided by the allowable bearing pressure — with deemed-to-satisfy tables in Approved Document A and the NHBC Standards covering most housing — and the depth comes from frost (external foundations are normally at least 450 mm deep in the UK), shrinkable clay, trees and the need to find undisturbed strata. Every trench is inspected before concrete, because a strip foundation poured over a soft spot or a desiccated root zone is a crack with a date on it.

When and why is Shallow Foundations used?

Shallow foundations follow earthworks and formation approval, and are chosen when the near-surface soils can carry the loads with acceptable settlement. Where weak ground, deep fill, mining or heavy loads rule that out, the design moves to rafts or piling. In the UAE, strips and pads suit villas founded on dense sands, while variable or salt-bearing sabkha ground pushes designs towards rafts and durability-led detailing. They matter because the foundation is the one element you can never economically replace.

Types of Shallow Foundations

Strip foundations

A continuous ribbon of concrete under load-bearing walls, typically 450–750 mm wide and 150–300 mm thick for housing. Trenchfill variants pour concrete nearly to ground level, saving blockwork below ground; traditional shallow strips have masonry brought up to DPC level. The default for domestic construction on decent ground.

Pad foundations

Isolated square or rectangular bases under columns, sized from load over bearing pressure and reinforced against bending and punching shear. Pads suit steel and frame construction where loads arrive at points. They can be linked by ground beams to carry walls and resist differential movement.

Raft foundations

A reinforced concrete slab spanning the whole footprint, spreading loads over the maximum area — the answer for weak or variable ground, mining areas and sites with made ground. Flat rafts, edge-thickened rafts and cellular rafts trade concrete for ground stiffness. Often cheaper than deep strips on poor ground once excavation and disposal are priced honestly, and the common answer in the Gulf where sabkha or variable sands make strip behaviour unpredictable.

Wide-strip and stepped foundations

On sloping sites strips are stepped at masonry-course increments, with the step overlap at least the depth or 300 mm. Where bearing is marginal, strips are widened and reinforced. Both are detailing exercises as much as calculations — the drawings must show every step and change of level.

Shallow Foundations: step by step

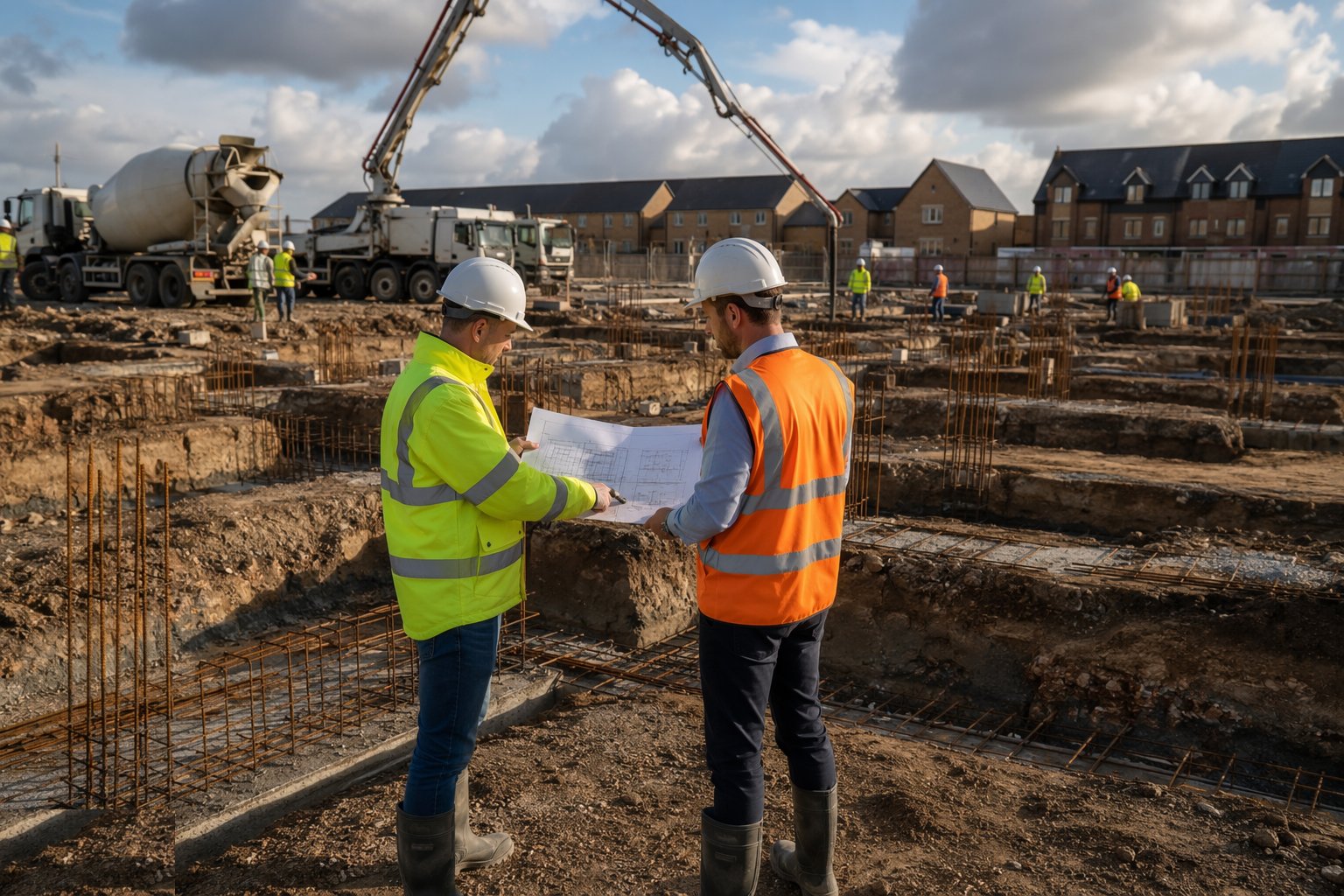

Step 1: Confirm the design against the ground investigation

Confirm the design against the ground investigation — Shallow Foundations, step 1

Check the foundation type, width and founding depth against the GI and any updates — a ground-bearing slab design on a site that turns out to have 2 m of fill needs to change before the dig, not during it. Confirm the allowable bearing pressure, the required founding stratum and any special measures for trees, clay or mining.

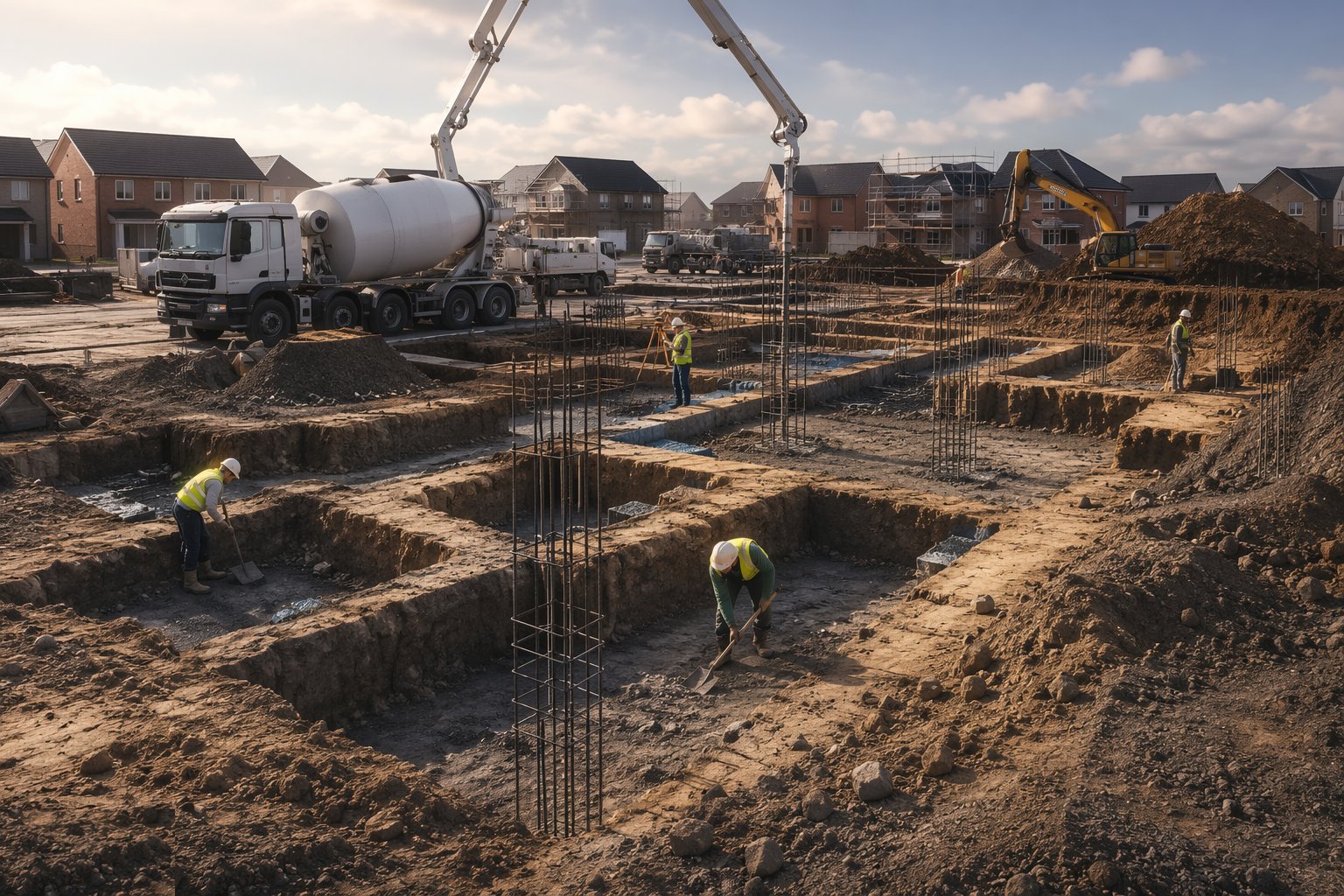

Step 2: Excavate trenches or pads to line and level

Excavate trenches or pads to line and level — Shallow Foundations, step 2

Dig to the setting-out profiles with a trenching bucket, keeping the base clean and undisturbed. Founding level is checked from the site datum as the dig proceeds. Over-dig is made good with concrete, never loose backfill. In clay, programme the dig to pour the same week — open trenches and wet weather are enemies.

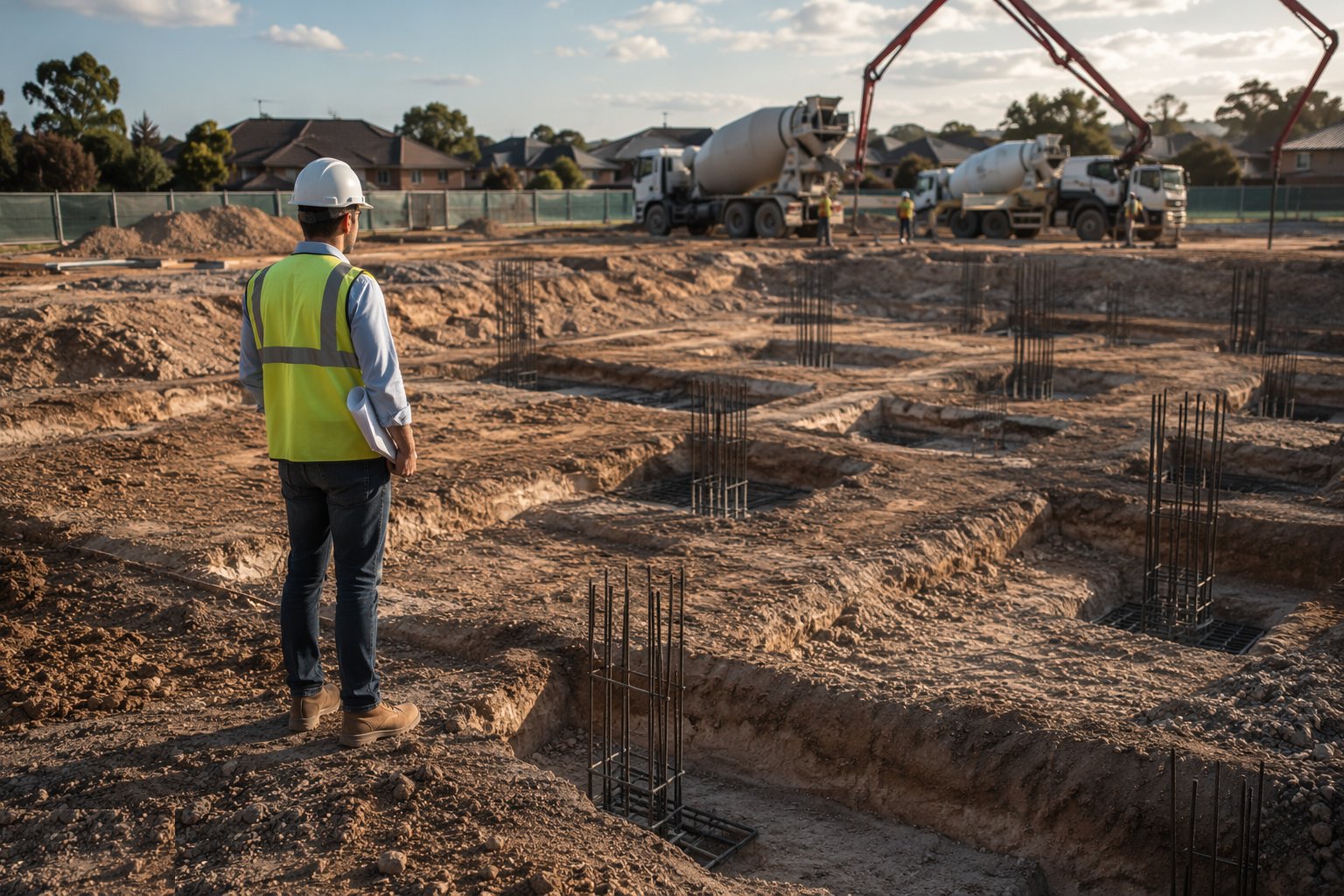

Step 3: Engineer's inspection of the formation

Engineer's inspection of the formation — Shallow Foundations, step 3

The hold point: the engineer or building control inspector examines the formation — correct stratum, no soft spots, roots, fill or water damage, and correct levels. Suspect material is dug out and replaced with mass concrete to a designed step-down. Approval is recorded on the inspection request before anything is poured.

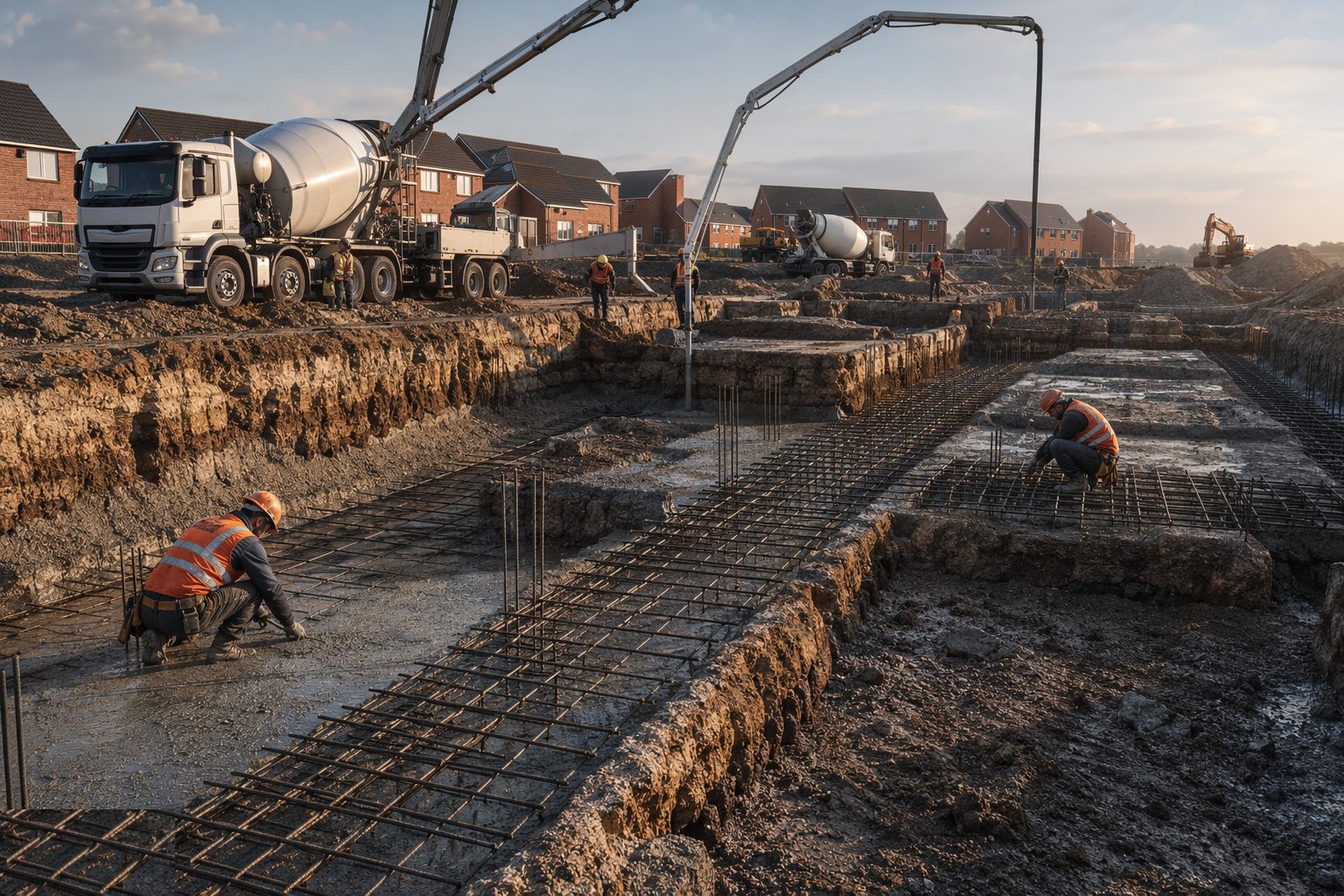

Step 4: Pour blinding and fix reinforcement

Pour blinding and fix reinforcement — Shallow Foundations, step 4

Where reinforcement is required, a 50–75 mm blinding layer gives a clean, level working surface. Mesh and bars are fixed to the bending schedule with the specified cover — typically 50–75 mm against ground — on chairs and spacers. Starter bars for walls or columns are templated so they land where the frame above needs them.

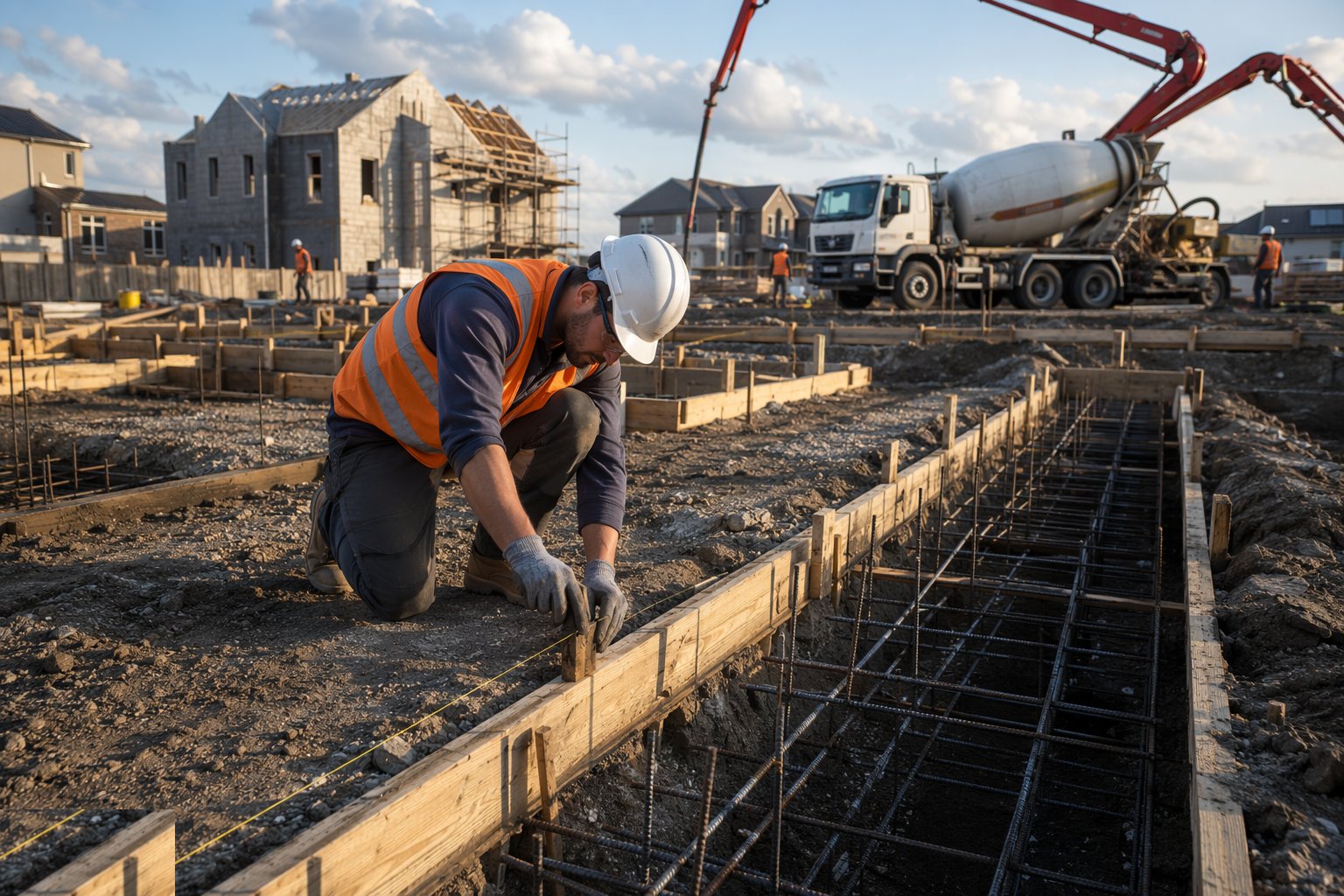

Step 5: Set out and check formwork or trench edges

Set out and check formwork or trench edges — Shallow Foundations, step 5

For pads and rafts, edge formwork is set to line and level from the control points; for trenchfill strips, the trench itself is the form. Check dimensions, diagonals and levels before the pour — concrete forgives nothing. Any ducts, sleeves or drainage crossing the foundation are positioned now or they become a breaker's job later.

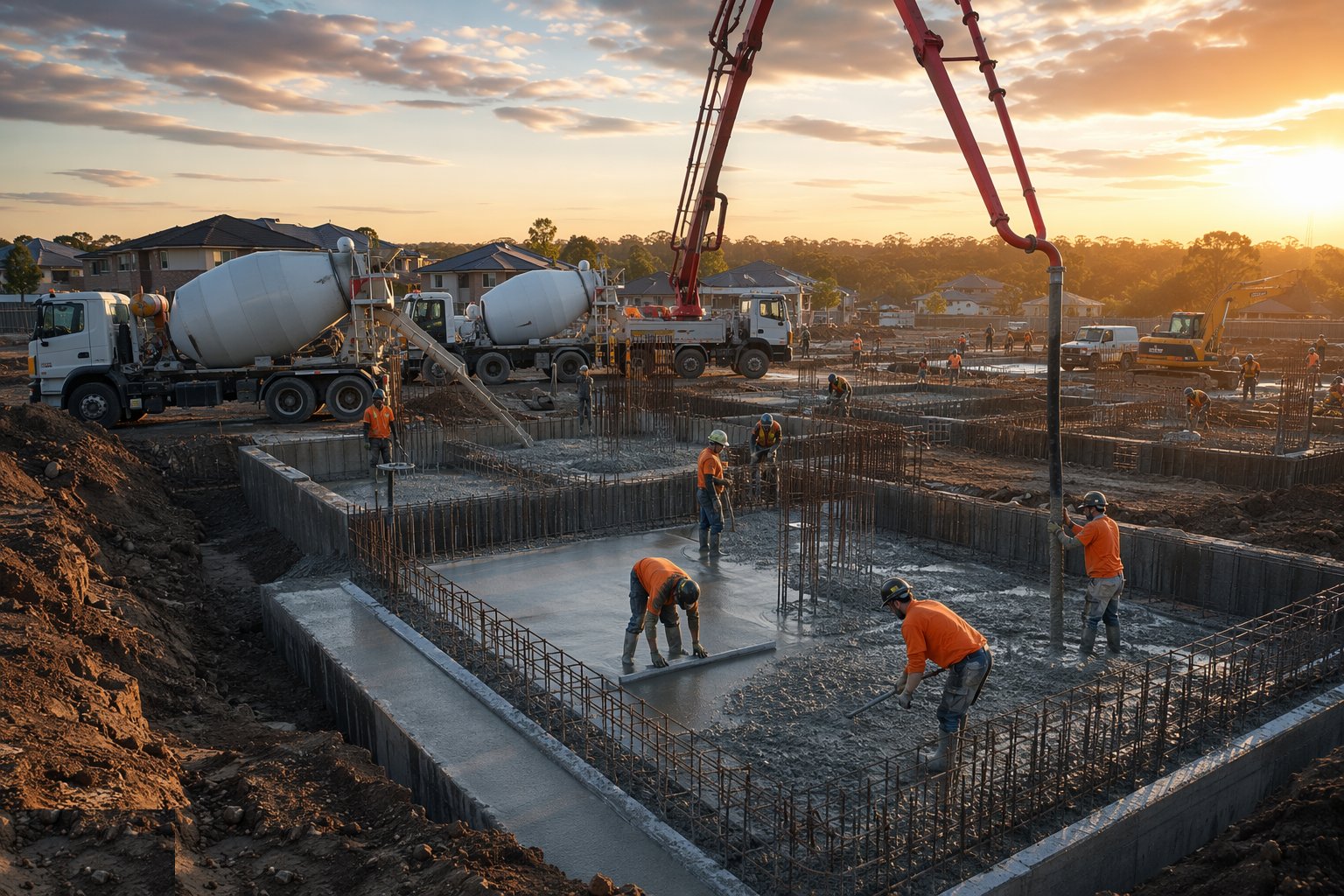

Step 6: Place and compact the concrete

Place and compact the concrete — Shallow Foundations, step 6

Concrete to the specified mix — commonly a GEN or RC mix to BS 8500, with the exposure class declared for ground contact — is placed by chute, pump or skip, and compacted with poker vibrators to expel air. Slump is checked on arrival for each load against the order; a wet load waved through today is a cracked, honeycombed foundation tomorrow. In the Gulf, chloride- and sulphate-bearing ground demands a sulphate-resisting or high-GGBS mix and increased cover, and hot-weather rules apply to every pour: chilled mix water or ice to keep delivered concrete near 25 °C, and no retempering with water on site. Finish the top to level for the masonry or the frame.

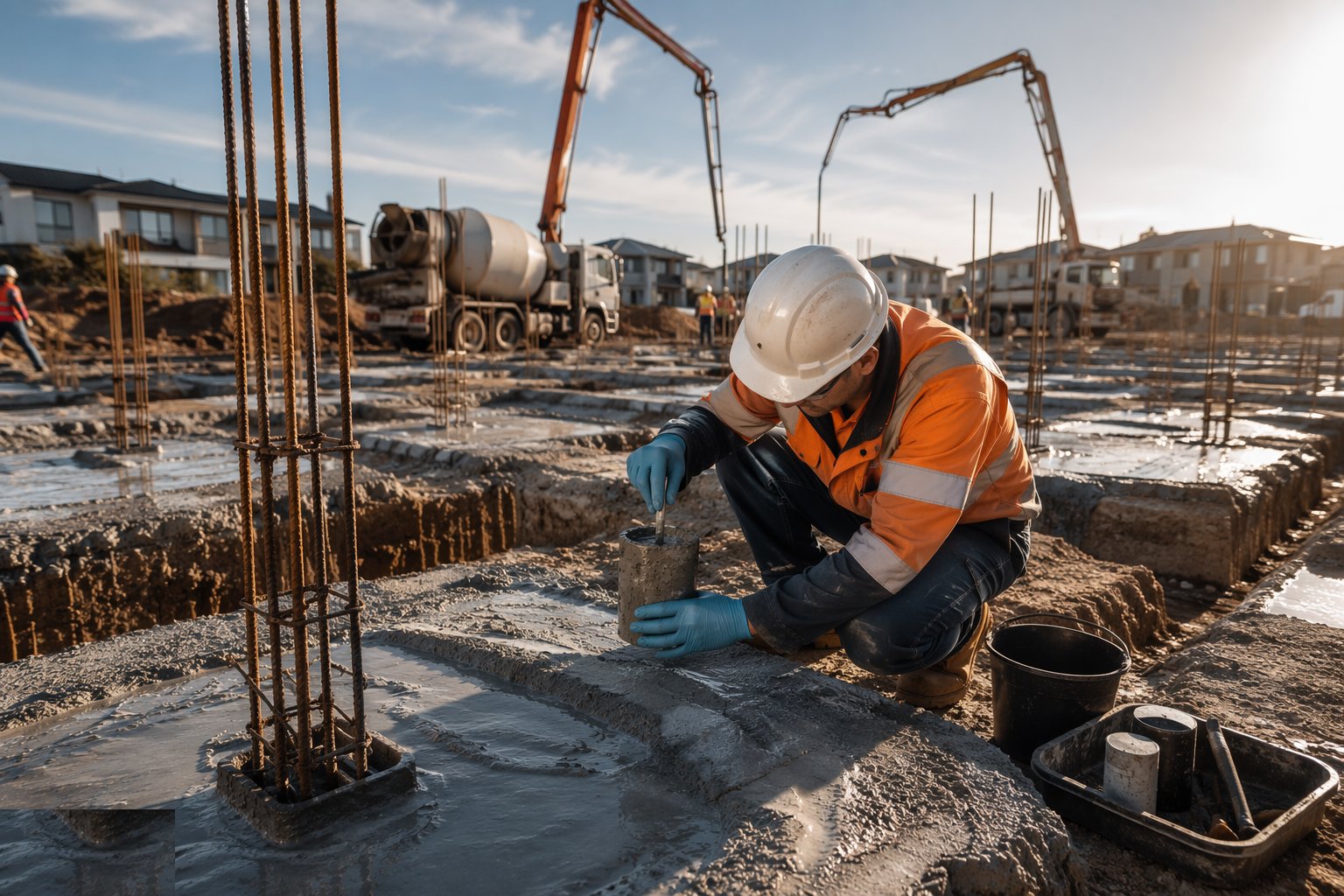

Step 7: Cure, protect and sample

Cure, protect and sample — Shallow Foundations, step 7

Test cubes are taken from the pour, marked and cured for crushing at 7 and 28 days — the objective evidence of strength. Fresh concrete is protected from frost, drying wind and rain; curing compound or hessian goes on where the surface will take masonry later. No loading until the concrete has gained sufficient strength, typically a minimum of three days for masonry above strips.

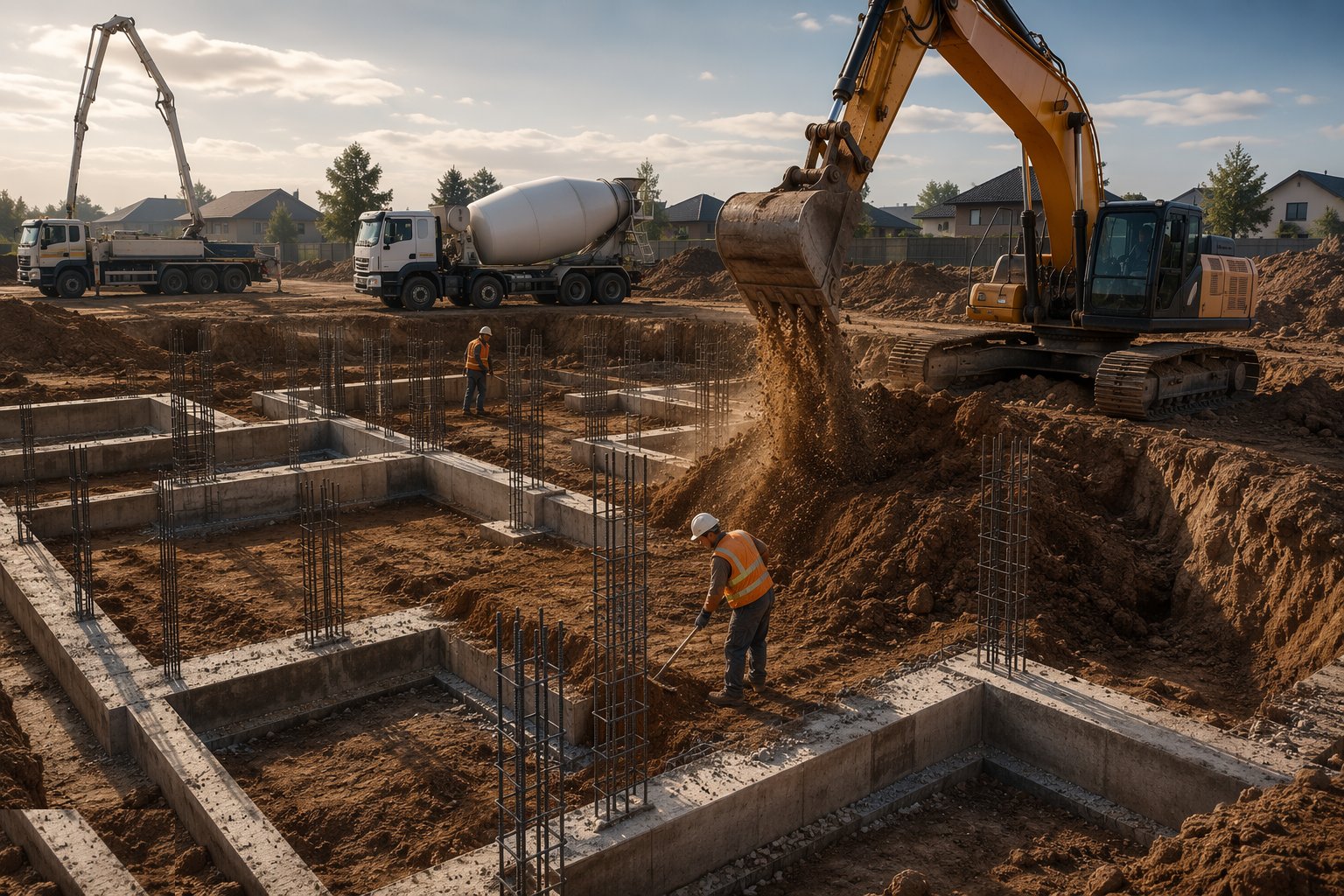

Step 8: Backfill and prepare for the next trade

Backfill and prepare for the next trade — Shallow Foundations, step 8

Once the concrete has hardened, trench sides are backfilled in compacted layers and the area is graded for the drainage and slab trades. Foundation positions and levels are as-built surveyed while everything is still visible. The QA file — inspection records, cube results, delivery tickets — is completed as the work proceeds, not reconstructed at handover.

Plant and equipment

Quality control checks

Safety considerations

Common defects

Best suited for

How long does Shallow Foundations take?

Typical duration: 2–5 days per typical house plot including excavation, inspection and pour; 1–3 weeks for a tower raft..
