Mechanical: ventilation and heating distribution

Ducts and pipework that own the ceiling void — gravity routes first, pressure and noise budgeted at every bend.

Mechanical: ventilation and heating distribution — MEP First Fix

Last updated 2026-07-28 by the BuildPedia Editorial Team.

What is Mechanical: ventilation and heating distribution?

Of everything competing for the ceiling void, ductwork is the least flexible, so it wins coordination priority right after drainage falls. Rectangular and spiral-wound circular duct is fabricated to a recognised construction standard, joints sealed, hangers fixed to structure at rated centres. Every bend, transition and poorly made joint costs static pressure and generates noise — so routes are straightened at coordination stage, bends are radiused where space allows, and the fan duty in the design is defended like money, because it is.

Heating distribution is the other half of the mechanical scope: flow and return from the boiler, plant room or heat interface unit out to every emitter, in copper, press-fit or multilayer pipe. Runs get falls to drain points and air vents at high points; expansion is taken by changes of direction or formed loops, with anchors and guides where the design puts them. Chilled and cold services get vapour-sealed insulation — an unsealed joint in a ceiling void condenses quietly for months before the stain appears on someone's finished ceiling.

Both systems disappear at boarding, so both are proven first. Ductwork is leakage-tested to its pressure class where specified; pipework is hydraulically pressure-tested with the gauge witnessed and the result recorded; only then does insulation close over the joints. Every concealed run is photographed dimensioned to the grid lines, because the duct nobody can see is the duct the ceiling installer crushes, and the photograph file is the only map anyone will ever have.

How does Mechanical: ventilation and heating distribution work, step by step?

Step 1: Set out from the coordinated ceiling plan

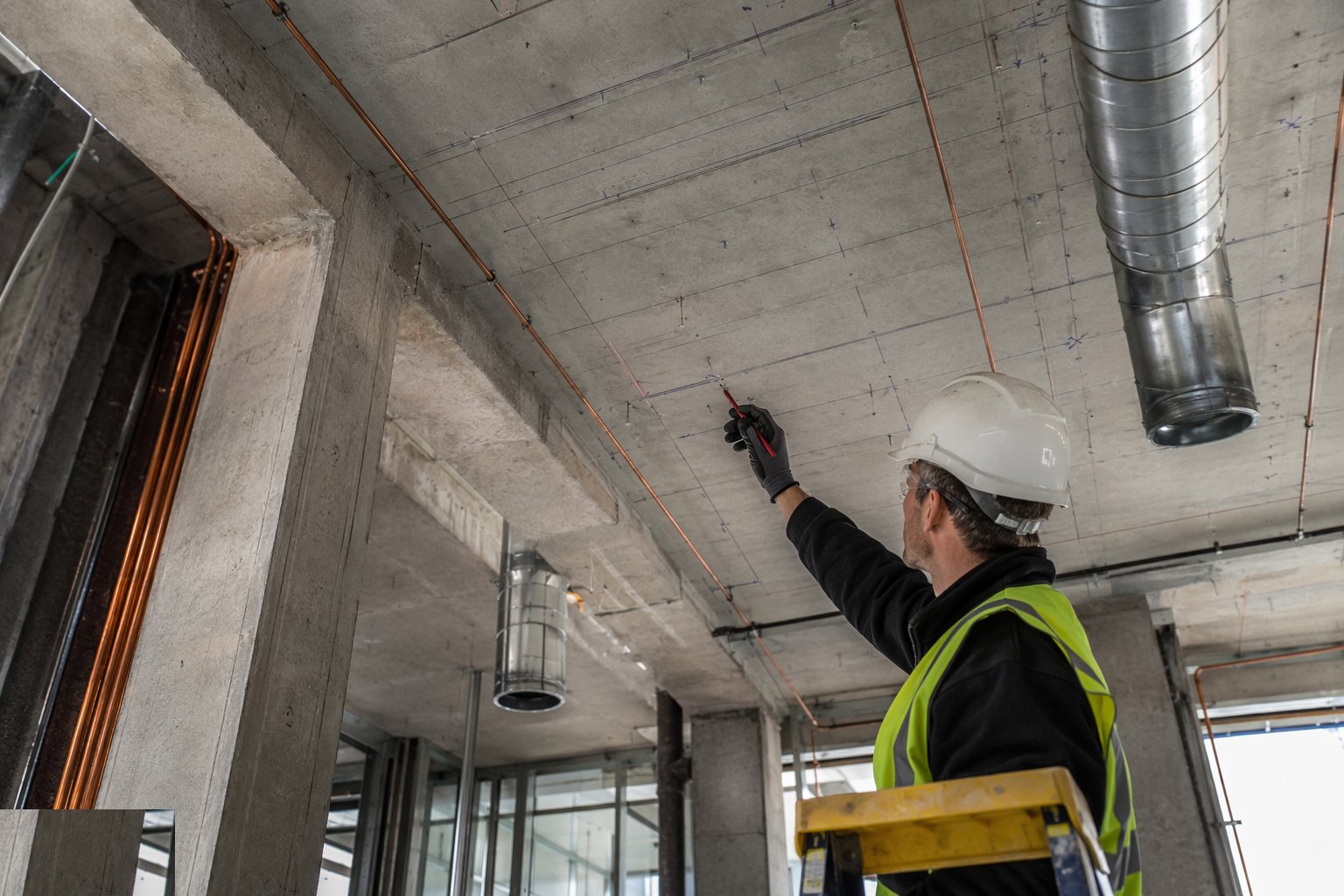

Set out from the coordinated ceiling plan — Mechanical: ventilation and heating distribution, step 1

Mark the routes and hanger positions on the soffit from the coordinated drawing, checked against the structure as-built — a beam 50 mm off its drawn position moves every service that crosses it. Duct levels are set from the site datum with the finished ceiling height protected; once a duct is hung low, no argument raises it again.

Step 2: Fabricate and hang the ductwork

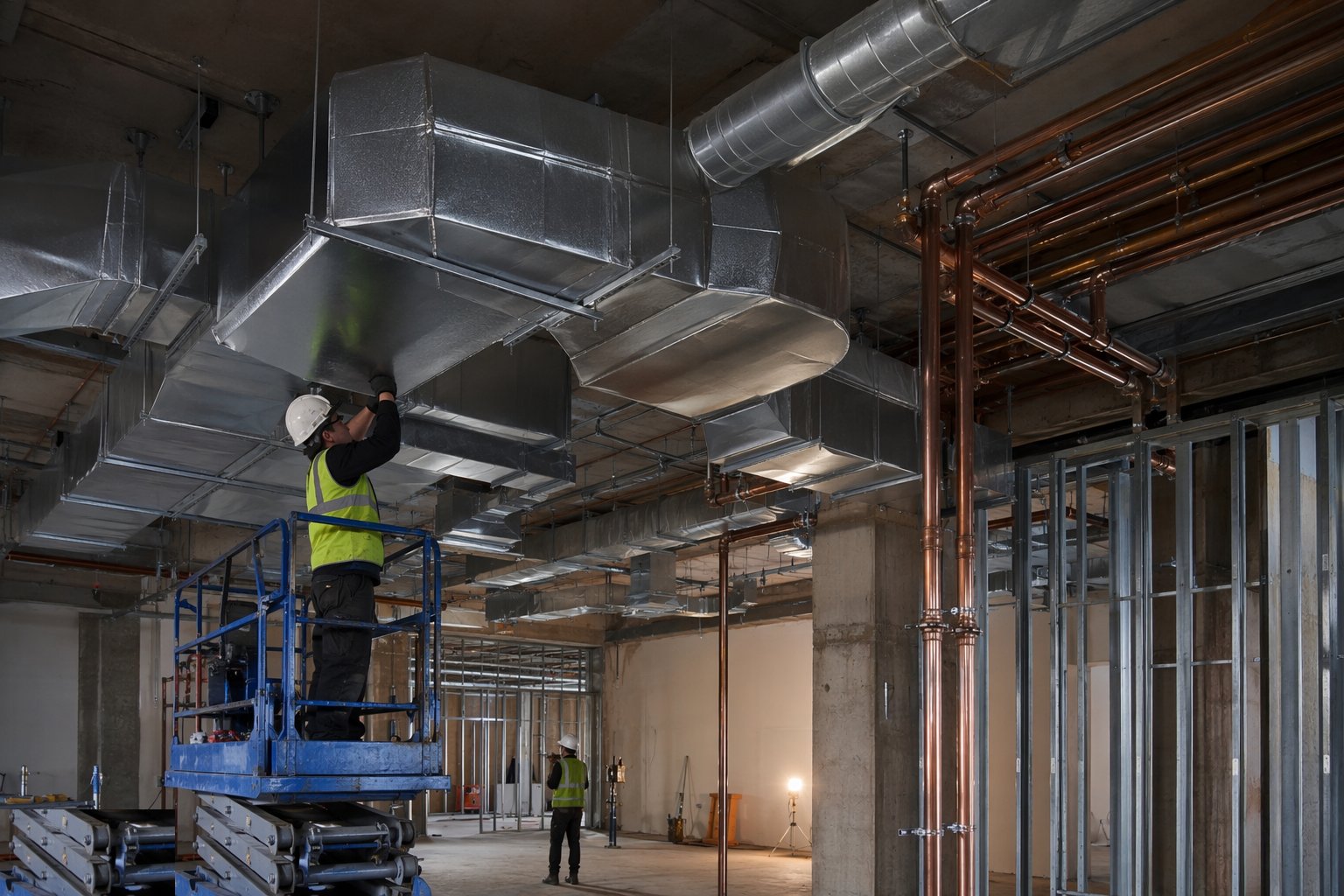

Fabricate and hang the ductwork — Mechanical: ventilation and heating distribution, step 2

Sections are assembled with sealed joints to the construction standard and hung from structure on threaded rod at rated centres — never from other services, never from the ceiling grid. Flexible connections at fans keep vibration out of the duct run, and long runs get the cross-joints and stiffening the standard demands for their pressure class.

Step 3: Install dampers, access and fire interfaces

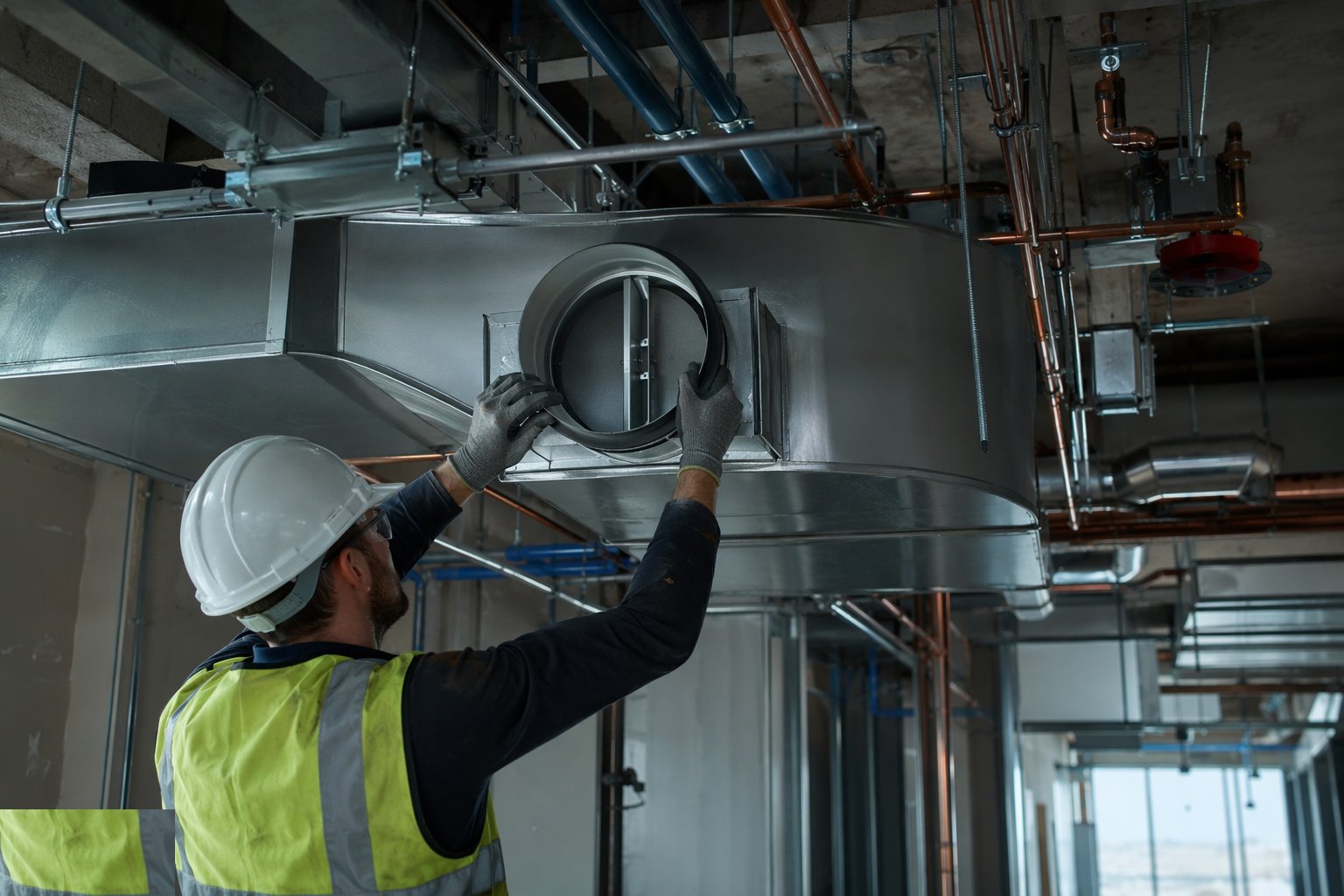

Install dampers, access and fire interfaces — Mechanical: ventilation and heating distribution, step 3

Volume control dampers go where the balancing engineer can reach them after the ceiling is up. Fire dampers at compartment lines are installed to the manufacturer's tested detail — correct substrate, correct fixing, access panel alongside — because a damper fixed to the wrong construction has no rating at all.

Step 4: Run the heating and chilled pipework

Run the heating and chilled pipework — Mechanical: ventilation and heating distribution, step 4

Flow and return are run with falls to drain points and vents at the high spots, sleeved through walls, and bracketed at designed centres with expansion accommodated by route or loop. Terminal tails to emitters are set from the finishes drawings — a pipe 30 mm off becomes an exposed offset after tiling.

Step 5: Test before anything closes

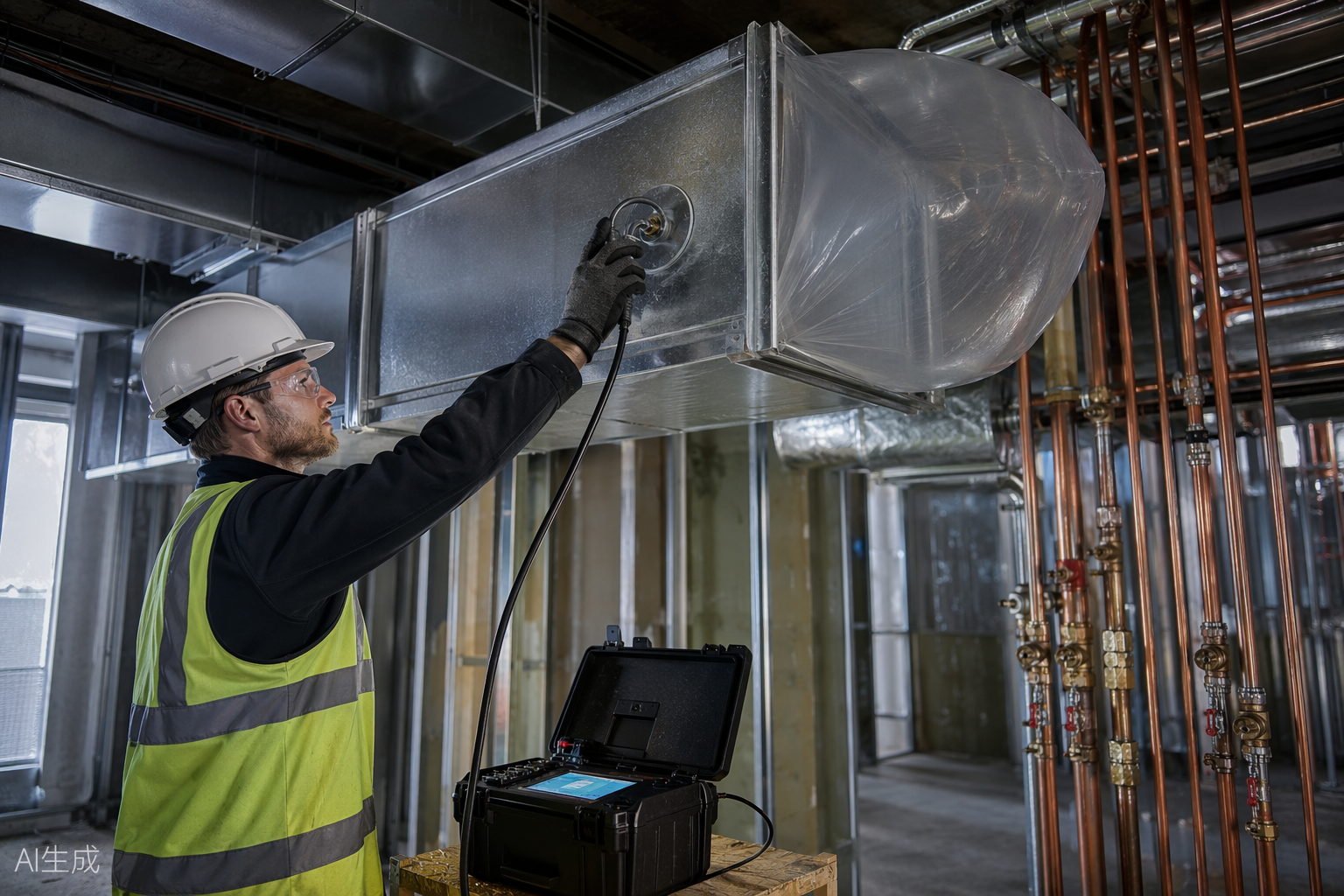

Test before anything closes — Mechanical: ventilation and heating distribution, step 5

Ductwork is leakage-tested against its specified pressure class, section by section. Pipework is hydraulically tested, held at test pressure with the gauge reading witnessed and recorded. A joint that weeps under test is remade now; a joint that weeps after boarding is a ceiling-down repair.

Step 6: Insulate, identify and record

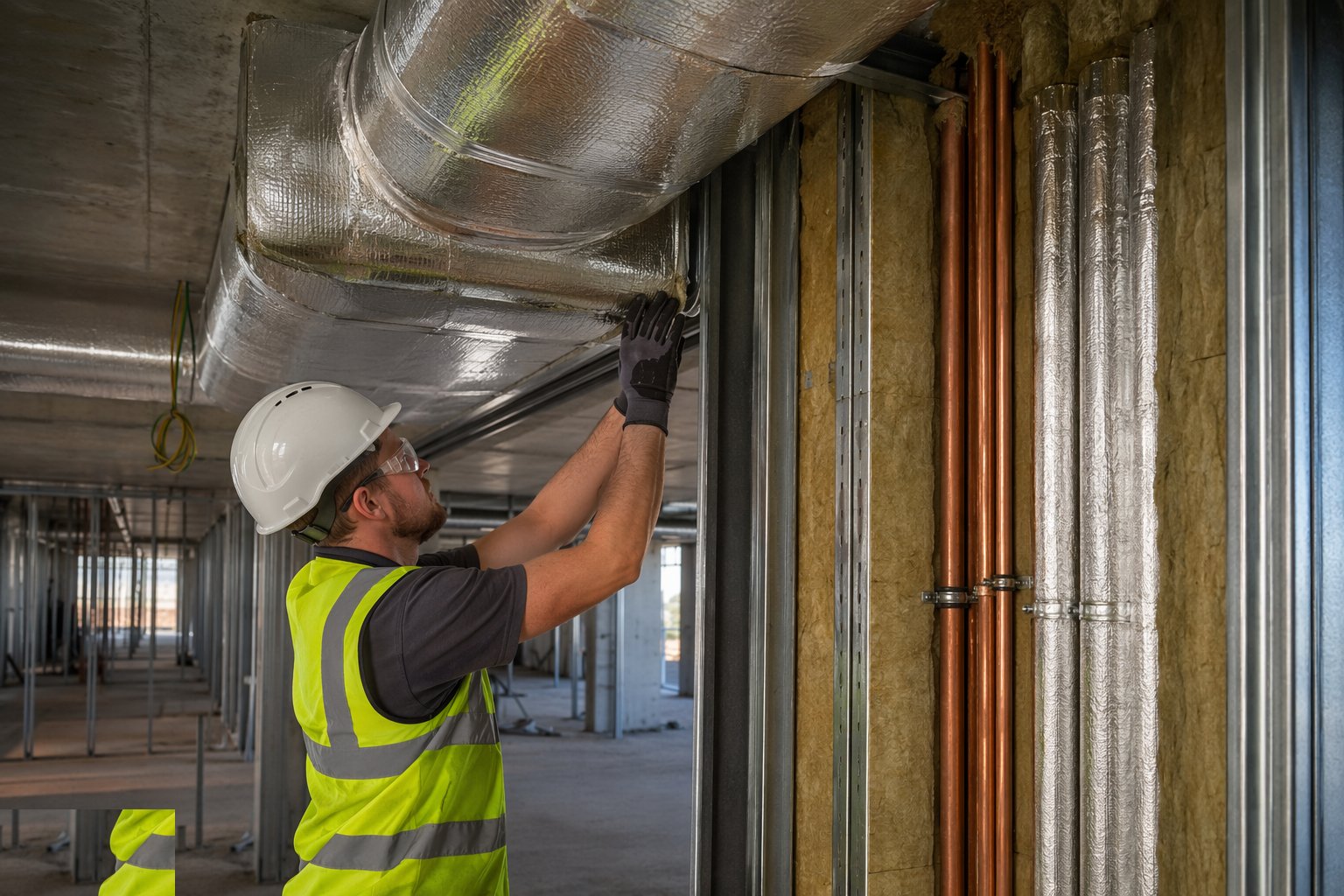

Insulate, identify and record — Mechanical: ventilation and heating distribution, step 6

Insulation goes on over proven joints, vapour-sealed on cold services with every butt and penetration closed. Flow arrows, valve tags and service labels identify the runs, the as-installed markup is updated, and dimensioned photographs of every concealed run are filed against the grid lines before the boarders arrive.
