Residential & HousingStep 01 / 22

Site Access & Enabling Works

Turning a piece of land into a controlled, serviced, legal construction site.

Last updated 2026-08-22

Typical duration

1–3 weeks on a housing site; 4–12 weeks on a constrained urban tower site.

What is Site Access & Enabling Works?

Site access and enabling works are the first operations on any project - making the site safe, secure and workable before a single bucket goes in the ground. They are everything that lets the real work happen: the hoarding that keeps the public out, the gates that keep plant moving, the cabins that house the team, and the temporary power and water that keep the whole show running. On a housing development this might take two weeks; on a tight city-centre tower it can be a project in its own right. In the UAE, no physical work may start before the building permit is issued, and the permit must come from the right authority - Dubai Municipality for mainland plots, the Dubai Development Authority in its communities, or Trakhees in the PCFC free zones - with RTA approval for any new access onto the road network. Submitting to the wrong authority is a classic, costly false start, so jurisdiction is confirmed by plot before anything is lodged.

This stage is also where the site's reputation with its neighbours is won or lost. Mud on the road, dust over the fence and a gate left open at night will generate complaints before the first foundation is poured. A well-set-up site - clean access, clear signage, working wheel wash, tidy welfare - is the first quality benchmark, and inspectors notice it the moment they arrive. In the UK, registering with the Considerate Constructors Scheme turns that first impression into a scored, monitored commitment, with the registration displayed on the hoarding.

Compare the methods at a glance

Method comparison graphic coming soon

When and why is Site Access & Enabling Works used?

Enabling works happen immediately after possession of the site, and before any intrusive work, because the law and the CDM regulations require welfare from day one, the public must be separated from the works, and plant cannot function without access, power and water. Skipping or skimping this stage costs far more later in delays, enforcement notices and neighbour disputes than it saves. In the Emirates the same logic applies, but the gatekeepers are the approvals: building permit, RTA access permit and the utility NOCs (DEWA, telecoms) all run in parallel rather than in sequence, and nothing intrusive starts until they are in hand. The same duties hold at the scale of a single house or an extension: welfare from day one, the public kept out and the access kept clean - the cabins and the hoarding get smaller, the obligations do not.

Walkthrough storyboard

The process in pictures, step by step - Step 1 of 8 - slide through the snapshots.

Topographical survey and site walkover

STEP 1

Topographical survey and site walkover

Before any set-up, confirm what you actually have: a topographical survey fixes existing levels, boundaries, trees and features, while a walkover with the…

Types of Site Access & Enabling Works

Explore each method in depth - benefits, limitations, plant and quality control on its own page.

Best suited for

  • Every project from a single house to a tower - the first process on any site
  • Constrained urban plots where hoarding, gates and neighbour protection define the boundary
  • Live environments - schools, hospitals, occupied estates - where access must be shared safely
  • Remote or unserviced land needing welfare, power, water and haul routes built from scratch
  • UAE plots where authority permits, site registration and boundary walls gate the start

Site Access & Enabling Works: step by step

  1. 1

    Step 1: Topographical survey and site walkover

    Before any set-up, confirm what you actually have: a topographical survey fixes existing levels, boundaries, trees and features, while a walkover with the utility drawings flags buried and overhead services. Mark out no-dig zones and overhead cable goalposts. This survey becomes the base drawing every later stage references. Trees to be retained are plotted and given root protection to BS 5837, and a photographic condition survey of neighbouring properties and the highway frontage gives a baseline against later damage claims.

    Topographical survey and site walkover
  2. 2

    Step 2: Erect hoarding, fencing and gates

    Solid timber hoarding (typically 2.4 m) goes up around public frontages; Heras-type mesh panels are acceptable away from the public. Gates are positioned so vehicles enter and leave in forward gear wherever possible, with vision splays kept clear. Hoarding lines are checked against the boundary survey - an encroachment discovered at month six is an expensive problem.

    Erect hoarding, fencing and gates
  3. 3

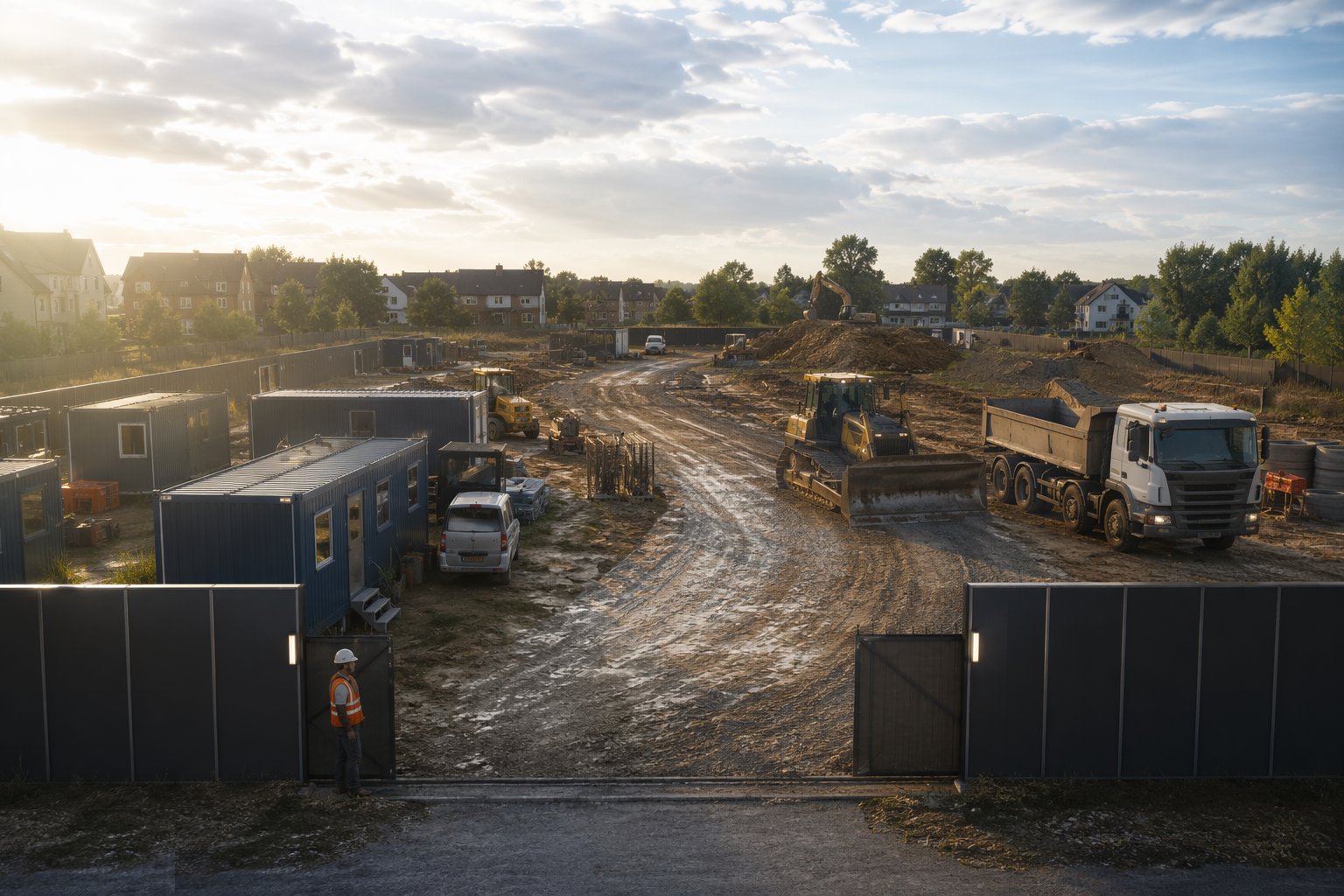

    Step 3: Form the access and haul road

    Strip topsoil on the access line, lay geotextile, and build up compacted Type 1 or crushed concrete to suit the heaviest expected axle load. A typical housing-site haul road is 300–450 mm of stone. Install the construction entrance with a clean-stone rumble strip or wheel wash at the gate to stop mud migrating onto the public highway.

    Form the access and haul road
  4. 4

    Step 4: Install wheel wash and wheel-cleaning facilities

    Position the wheel wash or rumble grid so every vehicle passes over it before the public road. Recirculating wheel-wash units need power, water and somewhere for the silt to settle. Keep a road sweeper on call-out for the first wet week - that is when the complaints arrive.

    Install wheel wash and wheel-cleaning facilities
  5. 5

    Step 5: Set up welfare facilities

    CDM requires welfare from day one: toilets, washing facilities with hot water, drinking water, a rest area and somewhere to dry clothes. Cabins are positioned on firm level ground outside crane radii and future excavation lines, with fire points and first-aid provision. Stack them if the footprint is tight.

    Set up welfare facilities
  6. 6

    Step 6: Bring in temporary power and water

    Apply for the temporary builder's supply early - utility lead times are measured in weeks, not days. A site distribution board feeds cabins, tower crane supplies and charging points through protected cables, either overhead on poles or buried in marked routes. Standby generators bridge the gap if the mains connection is late.

    Bring in temporary power and water
  7. 7

    Step 7: Drainage, water management and environmental controls

    Cut-off ditches and silt traps stop dirty water leaving the site; discharge to a watercourse or sewer needs consent. Fuel storage is bunded, spill kits are stationed at the gate, and dust and noise monitoring points are agreed with the environmental health officer where required.

    Drainage, water management and environmental controls
  8. 8

    Step 8: Signage, lighting and security

    Statutory signage, the project board, pedestrian routes and delivery instructions go up before trades arrive. CCTV, lighting and either guards or remote monitoring protect the site out of hours. The emergency plan, assembly point and fire plan are briefed at every induction from this point forward.

    Signage, lighting and security

Plant & equipment

  • Hoarding panels, Heras fencing and gate sets
  • Site cabins / welfare units and toilet blocks
  • Wheel wash or rumble grid, road sweeper
  • Generator and temporary distribution boards
  • Water bowser and standpipes
  • 360° excavator and dumper for haul road formation
  • Telehandler for offloading cabins and materials
  • CCTV, lighting towers and alarm systems

Quality control & testing

  • Boundary line verified against title plan before hoarding is fixed
  • Photographic condition survey of adjacent properties and highway filed
  • Haul road compaction and CBR checked if heavy plant is expected
  • Utility connection certificates and temporary supply test certificates
  • Welfare facilities checklist against CDM requirements
  • Discharge consents in place before any dewatering or washout
  • Weekly site security and fencing inspection recorded

Safety watchpoints

  • Public protection: intact hoarding, self-closing gates, pedestrian segregation
  • Traffic management plan with one-way routes and 5 mph limit
  • Banksmen for reversing vehicles and deliveries
  • Overhead cable goalposts and buried-service permits before digging
  • Bunded fuel storage and spill response
  • Out-of-hours lighting and emergency contact board

Common defects to hunt

  • Mud tracked onto the highway - fines and a summons for the sweeper
  • Hoarding panels down in high wind where ballast was skimped
  • Haul road rutting and pumping because the geotextile was omitted
  • Cabins positioned where the crane or the plot line later needs to be
  • Temporary power overloaded once the tower crane and cabins run together
  • Silt-laden water discharged without consent

How long does Site Access & Enabling Works take?

Typical duration: 1–3 weeks on a housing site; 4–12 weeks on a constrained urban tower site..

Related processes
